Skip to content
MaintWiz: Innovating Industrial AI

Plant shutdown guide

What Is Shutdown Maintenance?

Short answer

Shutdown maintenance is planned maintenance work carried out while a plant, or part of a plant, is deliberately taken out of service. It covers work that cannot be done safely or practically while equipment runs, such as intrusive inspection, major repair and modification. The work is scoped and scheduled well in advance; large periodic events are commonly called turnarounds.

In this guide, shutdown maintenance means the work, and a shutdown is the stop itself.

How MaintWiz helps: Most shutdowns still run on spreadsheets, calls and paper. The MaintWiz shutdown module moves the plan from spreadsheets into one system with a critical path, readiness gates, permits and spares status. See the module · Get the 40-step checklist

By · Published · Last reviewed

What MaintWiz adds:Critical path and floatReadiness gatesPermits and isolationsSpares status with SAP

Terms

How do shutdown, turnaround and outage fit together?

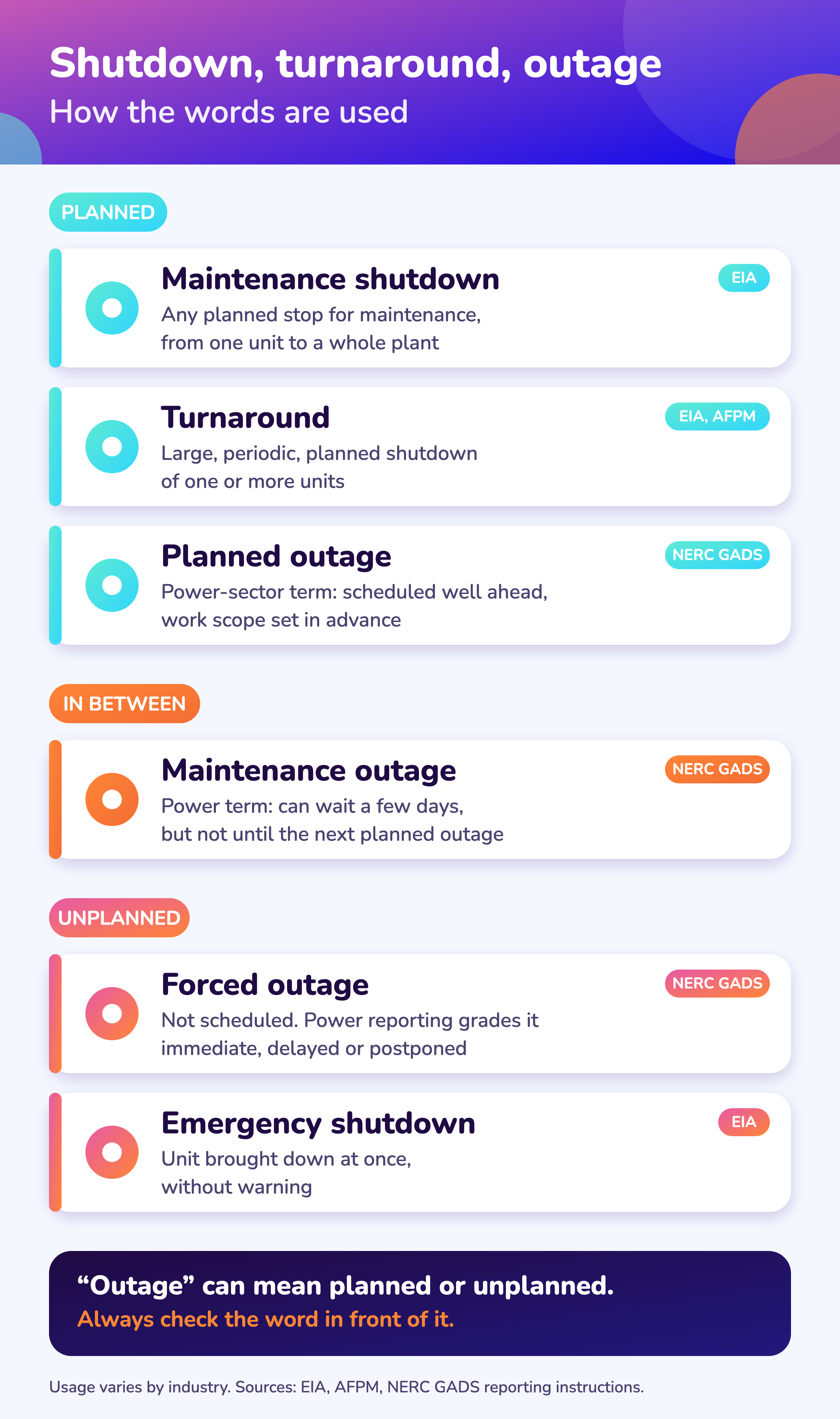

Shutdown, turnaround and outage all describe a plant or unit being out of service, but the words are used differently by industry. A turnaround is usually the large, planned, periodic form of shutdown. “Outage” can mean a planned or an unplanned stop, so check the word in front of it.

Each term here and many more are defined with a named source in the shutdown turnaround glossary.

Planned

  • Maintenance shutdownAny planned stop for maintenance, from one unit to a whole plantEIA
  • TurnaroundLarge, periodic, planned shutdown of one or more unitsEIA, AFPM
  • Planned outagePower-sector term: scheduled well ahead, work scope set in advanceNERC GADS

In between

  • Maintenance outagePower term: can wait a few days, but not until the next planned outageNERC GADS

Unplanned

  • Forced outageNot scheduled. Power reporting grades it immediate, delayed or postponedNERC GADS
  • Emergency shutdownUnit brought down at once, without warningEIA
“Outage” can mean planned or unplanned. Always check the word in front of it.

Definitions in detail

Shutdown, turnaround and outage terms compared
TermPlanned?MeaningSource
Maintenance shutdownPlannedAny planned stop for maintenance, from a targeted stop of one unit to a whole plant. EIA also describes planned, targeted shutdowns of smaller scope than a turnaround.EIA
TurnaroundPlanned, periodicA planned, periodic shutdown of one or more processing units for maintenance, inspection and repair. AFPM says the key distinction from an unplanned outage is that turnarounds are planned.EIA, AFPM
Planned outagePlannedPower-generation term: scheduled well in advance, of predetermined duration, with the work scope determined beforehand.NERC GADS
Maintenance outageDeferrablePower-generation term: can be deferred past the next weekend but must happen before the next planned outage.NERC GADS
Forced (unplanned) outageUnplannedNot scheduled. Power-generation reporting grades it as immediate, delayed or postponed.NERC GADS
Emergency shutdownUnplannedA unit or whole refinery brought down immediately, without warning.EIA

Full comparison with regional terms: Turnaround vs shutdown vs outage. Classification by trigger and scale: Types of plant shutdowns.

Numbers

How often, how long and how far ahead?

US refinery turnarounds are planned every 3 to 5 years after 1 to 2 years of preparation, and US reactor refueling outages recently averaged 34 to 38 days (nuclear outage guide). 1,4 These are published examples, not universal benchmarks, and other sectors have no public figure.

  • 3–5 yrsRoutine turnaround interval on key US refinery units1
  • 1–2 yrsAdvance planning for a refinery turnaround1
  • 18–24 moUS reactor refueling cycle; outages average about 2 months4
  • 15–20 yrsBlast furnace campaign life operators aim for between relines20
Published examples of shutdown frequency, duration and lead time by industry
IndustryUsual termPublished examplesSource
Refining (US)TurnaroundRoutine turnarounds on key units are planned every 3 to 5 years. A unit can be offline for several weeks to several months, after 1 to 2 years of advance planning. Typically scheduled in spring or fall.EIA, AFPM
Power generationPlanned outage, overhaulReporting rules describe a planned outage as scheduled well in advance, of predetermined duration, lasting several weeks and occurring once or twice a year. Generator maintenance is typically placed in spring and fall (New England data, 2011).NERC GADS, EIA
Nuclear power (US)Refueling outageReactors refuel after about 18 or 24 months of full power operation. An outage recently averaged 34 to 38 days and can be as short as 10 days. Scheduled in spring and fall.EIA
Iron and steelBlast furnace relineOperators aim for campaigns of 15 to 20 years between relines. One German furnace reline in 2008 was reported at a record 70 days of downtime, against over 80 days for its 1996 reline.EU study, AIST
Cement, chemicals, pharmaceutical, food and beverage, mining, water, general manufacturingAnnual shutdown, planned outage, overhaulNo public, vendor-neutral benchmark found. Intervals and durations follow the equipment, regulation and production calendar. See the industry guides below.Industry guides

Read with care. Most figures are from US refining and power generation. Do not apply refinery intervals to a manufacturing plant’s annual shutdown.

MaintWiz

How can MaintWiz help with shutdown maintenance?

Most shutdowns still run on spreadsheets, calls and paper. The MaintWiz shutdown module moves the plan from spreadsheets into one system with a critical path, readiness gates, permits and spares status.

About MaintWiz. MaintWiz is an industrial AI platform with IoT, SAP integration and predictive maintenance (PdM) capabilities. Its shutdown and turnaround module helps plants plan, schedule, execute and close out shutdown work.

What the shutdown module covers

As described on the MaintWiz shutdown maintenance product page.

  • Critical path and float
  • Readiness gates
  • Permits and isolations
  • Spares status with SAP

Maintenance types

How is shutdown maintenance different from preventive maintenance?

Preventive maintenance is a type of maintenance task. Shutdown maintenance is a way of scheduling work in a window when equipment is out of service, and it can include preventive tasks, inspection, corrective repair, replacement and modification.

The US Department of Energy’s Federal Energy Management Program defines preventive maintenance as actions performed on a time- or run-time-based schedule that detect, preclude or mitigate degradation, to sustain or extend useful life. Predictive maintenance, by contrast, uses measurements that detect the onset of degradation. Both kinds of work can be placed in a shutdown window. 6

Routine preventive maintenance compared with shutdown maintenance
AspectRoutine preventive maintenanceShutdown maintenance
Equipment stateUsually one asset at a time, often while the rest of the plant runsPlant or unit out of service
Work volumeOne or a few work ordersMany work orders at once, some in a set sequence
PlanningStanding scheduleProject-style plan with scope, budget, critical path and approvals
Types of workScheduled preventive tasksPreventive, inspection, corrective, replacement, modification and statutory work

The UK Health and Safety Executive advises minimizing isolation requirements wherever practicable by planning intrusive maintenance for shutdown periods, and says work on live plant needs a high standard of management. 7

Why

Why do plants take planned shutdowns?

Maintenance technician holding a tablet in a manufacturing hall, framed in a hexagon
Illustration (synthetic image): A technician reviews work on a tablet on a manufacturing floor. A shutdown moves this kind of work into one planned window.

Access

Intrusive work needs equipment emptied and isolated. HSE guidance says to plan intrusive maintenance for shutdown periods to minimize isolation requirements. 7

For the cost difference, see planned vs unplanned shutdown cost.

Purpose

EIA gives the purposes of a turnaround as maintenance, inspection and repair, replacing process materials and equipment that have worn out or broken, and ensuring safe and efficient operation. 1

Statutory inspection

Some stops are driven by law. India’s Boilers Act, 2025 provides that a boiler certificate authorizes use for a period not exceeding twelve months (section 12(6)), and the Factories Act (replaced by the OSH Code, 2020 from 21 November 2025) lets state governments make rules for the examination and testing of pressure plant (section 31(2)). The 2025 Act comes into force on a date the central government notifies. 15,14

Timing

Planned stops can be placed in low-demand seasons so capacity is available at peak: spring and fall for US refining and for generators. 2,3

Scope

What is shutdown maintenance work, and what goes into it?

A shutdown’s work scope is the planned scope plus any approved work found along the way. Plants that run continuously, such as power plants and refineries, generally have larger and more complex scopes than plants that run in shifts.

  • Maintenance backlog set aside for the shutdown window
  • Inspections that need equipment out of service, such as boilers and pressure vessels
  • Cleaning, inspection and repair of utilities, pipelines and storage tanks
  • Corrective work on known defects and performance deterioration
  • Planned preventive tasks and improvements identified by predictive maintenance
  • Replacement or overhaul of equipment and components
  • Modifications, such as pollution-control or energy-saving retrofits
  • Safety and reliability improvements

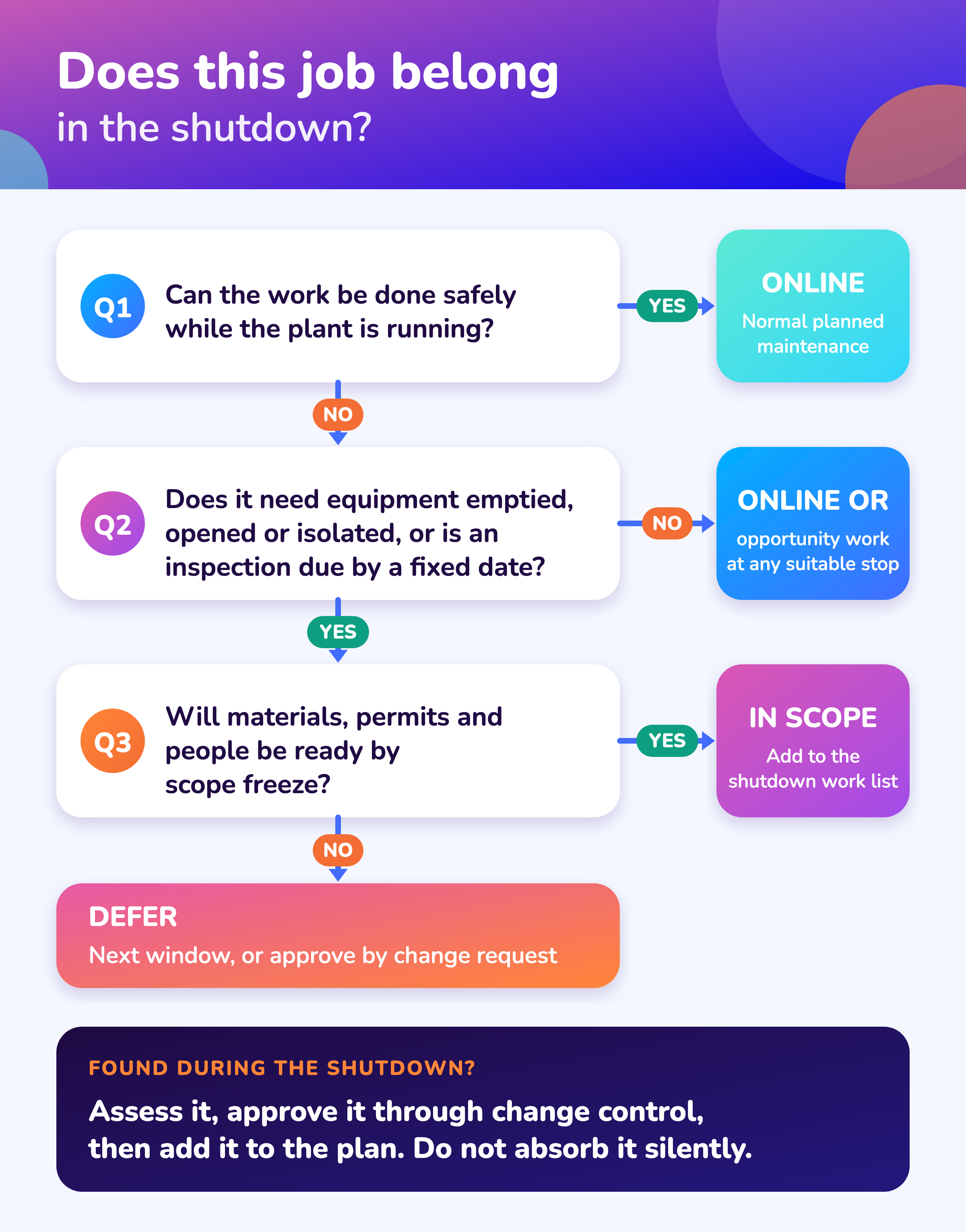

A simple test for whether a job belongs in the shutdown

  1. Q1Can the work be done safely while the plant is running?
    YES → ONLINENormal planned maintenanceIf no, go to Q2
  2. Q2Does it need equipment emptied, opened or isolated, or is an inspection due by a fixed date?
    NO → ONLINE OR OPPORTUNITY WORKAt any suitable stopIf yes, go to Q3
  3. Q3Will materials, permits and people be ready by scope freeze?
    YES → IN SCOPEAdd to the shutdown work listIf no, defer to the next window, or approve by change request
Found during the shutdown? Assess it, approve it through change control, then add it to the plan. Do not absorb it silently.

Planned scope and discovered work are different things. NERC’s generator reporting rules require that for a planned outage the individual tasks be determined in advance as the “original scope of work”, and treat discovery work and re-work as outside it. In practice, fix the scope early and assess newly found work through a change process instead of absorbing it silently. 5 Where OSHA’s Process Safety Management standard applies, changes to equipment and procedures other than replacements in kind need written management-of-change procedures. 11

More: Shutdown scope definition · Work packages · Risk assessment.

Types

What are the types of shutdown?

Types of shutdown by trigger, extent and scale
Classified byTypeWhat it isSource
TriggerPlannedScheduled in advance, with scope, budget and resources set before the stop.EIA, NERC GADS
TriggerStatutory or inspection-drivenSet by a legal inspection or certificate date, for example a boiler certificate or pressure plant examination.Boilers Act 2025, Factories Act 1948
TriggerSeasonal or low-demand windowPlaced where demand is lowest, for example spring or fall in US refining and generation.AFPM, EIA
TriggerEmergency or forcedA unit is brought down immediately, or an unplanned outage is taken.EIA, NERC GADS
ExtentPartial or targetedOne or more units, or a smaller scope than a turnaround.EIA
ExtentFull plantThe whole plant or refinery is taken out of service.EIA
ScaleRoutine shutdown or turnaroundTurnarounds are the large, periodic form; routine shutdowns are smaller and more frequent.EIA, AFPM

Detailed classification: Types of plant shutdowns.

Process

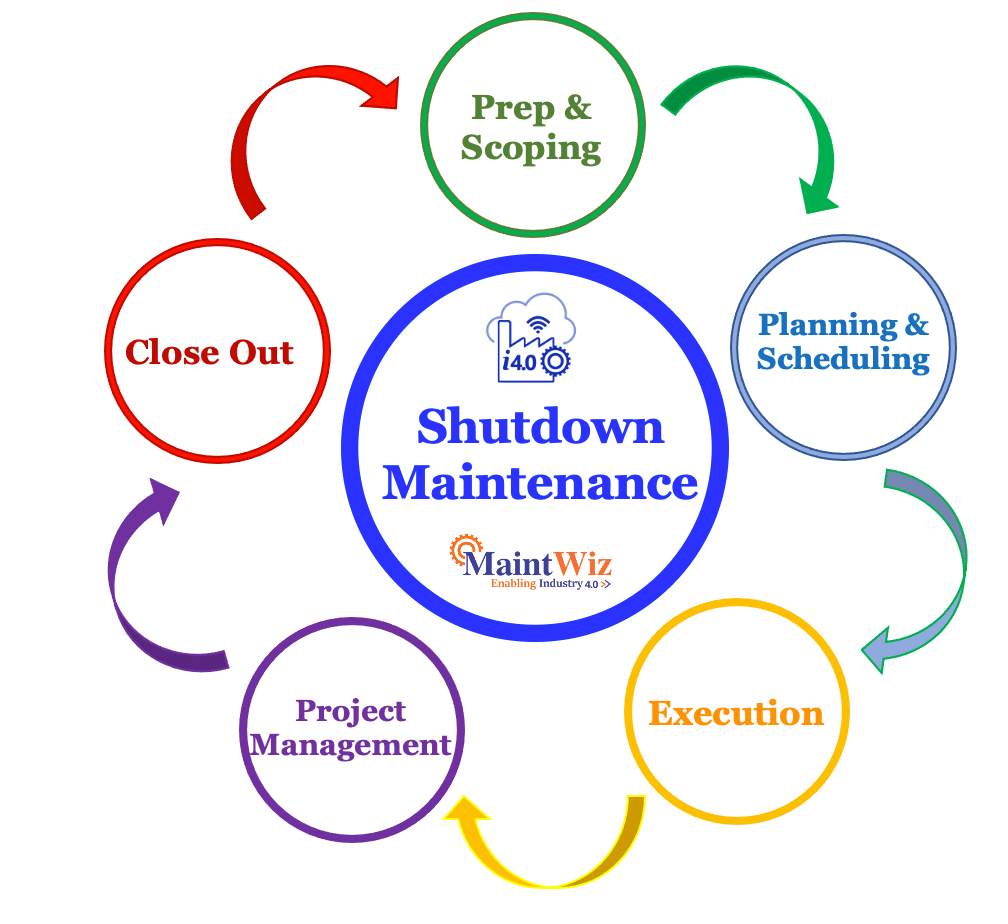

What are the phases of a shutdown?

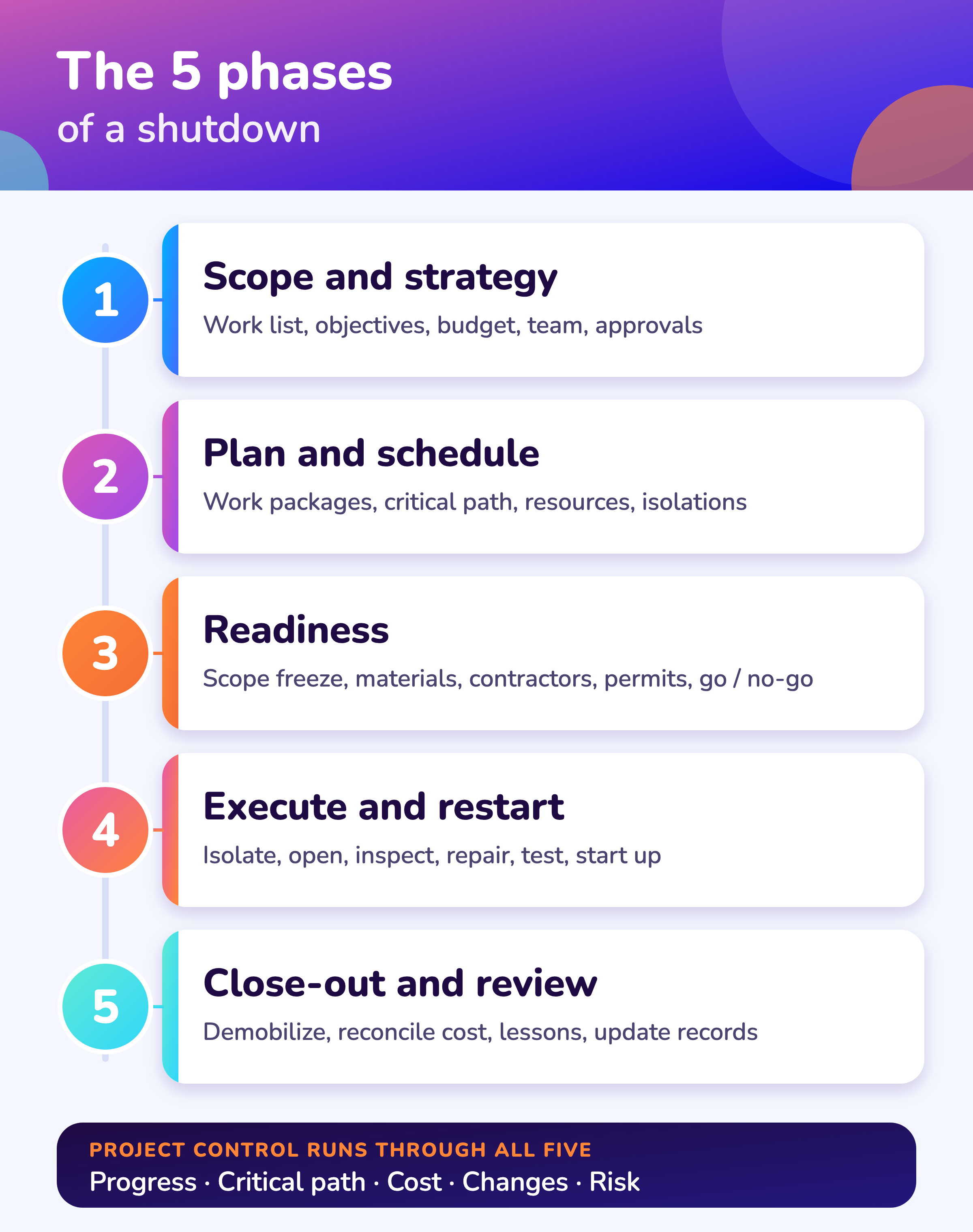

A shutdown has five phases, with project control running through all of them.

  1. 1

    Scope and strategy

    Collect the work list from the backlog, inspection findings and past shutdowns. Set objectives, timing and a cost estimate. Define the team and roles. Obtain approvals.

    Outputs: Approved scope, budget, dates, team
  2. 2

    Plan and schedule

    Break the scope into work packages with job plans. Sequence the work and find the critical path. Plan resources, permits, external approvals, spares, tools, logistics and isolations.

    Outputs: Work packages, schedule, resource and material plan, isolation plan
  3. 3

    Readiness

    Freeze the scope. Confirm materials and contractors. Complete training. Prepare permits and isolations. Hold a go / no-go review.

    Outputs: Readiness sign-off
  4. 4

    Execute and restart

    Mobilize, shut down in the planned sequence, isolate, inspect, clean, repair and replace, calibrate, check quality, assess discovered work, then restart in the planned sequence.

    Outputs: Completed work, inspection records, safe restart
  5. 5

    Close-out and review

    Demobilize, close permits and contracts, reconcile cost and schedule, review performance and lessons, report to management.

    Outputs: Close-out report, lessons learned, updated asset records
Project control, across all phases: track progress against the baseline, monitor the critical path, report cost and schedule variance, manage communication between planning, operations, contractors and management, control changes, and manage risk.

Detail: Planning process · When to schedule · Scheduling · Execution · 40-step checklist.

Safety

What safety and compliance controls apply during a shutdown?

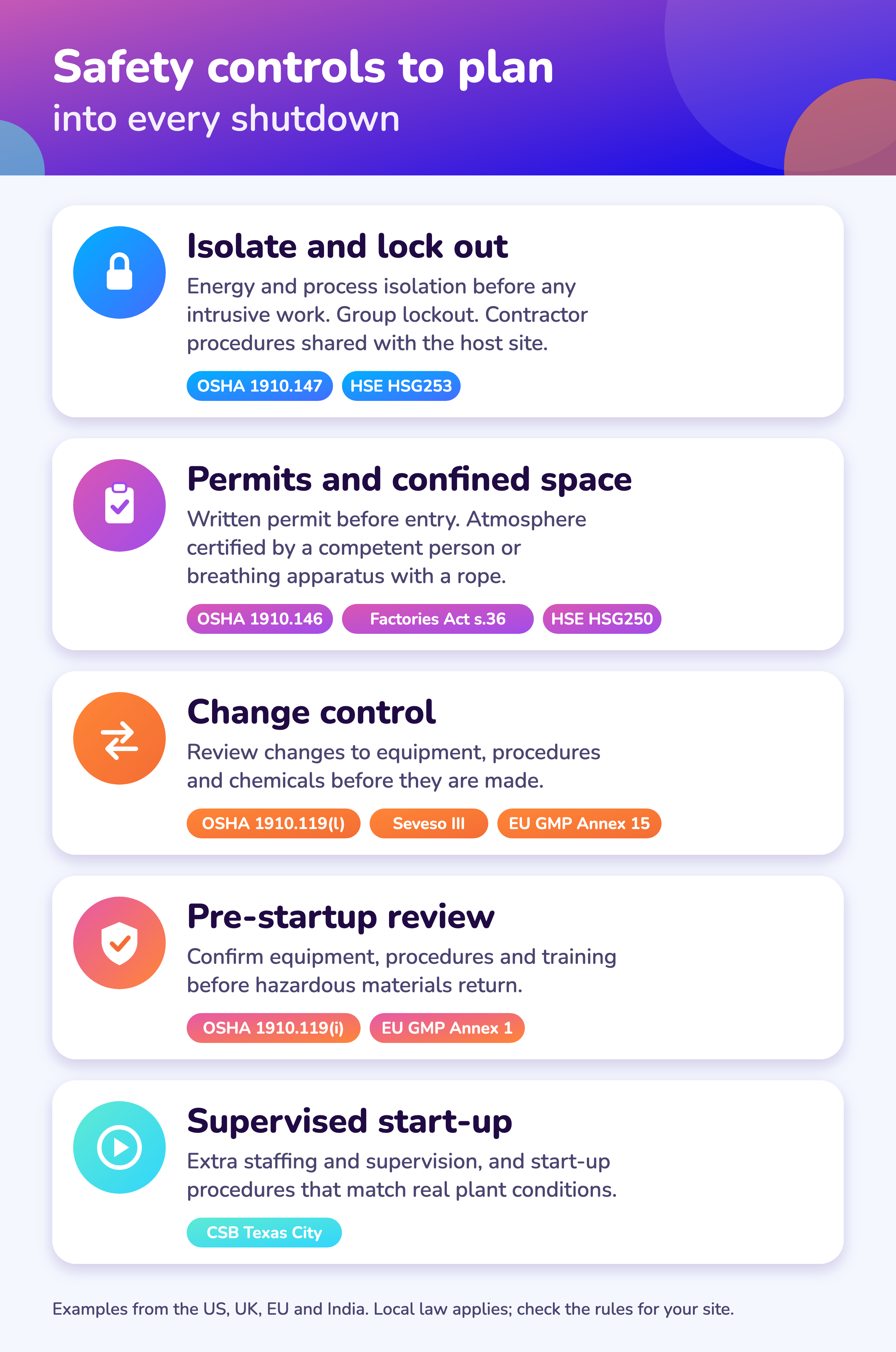

Shutdown safety rests on isolation and lockout, permits and confined space controls, change control, a pre-startup review, and supervised start-up. The rules differ by country, so the table gives examples. It is not legal advice.

Isolate and lock out

Energy and process isolation before any intrusive work. Group lockout. Contractor procedures shared with the host site.

Permits and confined space

Written permit before entry. Atmosphere tested and certified by a competent person before entry; breathing apparatus with a lifeline is a fallback for a space that cannot be made safe to breathe, not a replacement for testing and rescue planning.

Change control

Review changes to equipment, procedures and chemicals before they are made.

Pre-startup review

Confirm equipment, procedures and training before hazardous materials return.

Supervised start-up

Extra staffing and supervision, and start-up procedures that match real plant conditions.

Examples by jurisdiction

Examples of shutdown safety rules by jurisdiction
JurisdictionIsolation and lockoutPermits and confined spaceProcess safety and change control
United States (OSHA)1910.147 covers servicing and maintenance where unexpected energization or release of stored energy could injure employees. It has group lockout provisions, requires host and contractor employers to inform each other of their procedures, and requires checks before energy is restored. 91910.146: a written permit space program, and an entry permit documenting the required measures before entry is authorized. 101910.119, where the standard applies: written management-of-change procedures (except replacements in kind) and a pre-startup safety review for modified facilities before hazardous chemicals are introduced. 11
United Kingdom (HSE)HSG253, The safe isolation of plant and equipment. It describes boundary isolation with spades or blinds as typically used on maintenance shutdowns or turnarounds. 7HSG250, guidance on permit-to-work systems for the petroleum, chemical and allied industries. 8—
European Union——Seveso III Directive: establishments with dangerous substances need a safety management system covering safe operation, including maintenance. Where a change could have significant major-accident consequences, the operator reviews its safety documents and informs the authority before the change. 13
IndiaFactories Act 1948, s.31: effective measures to keep pressure plant within its safe working pressure, with state rules for examination and testing. 14Factories Act 1948, s.36: entry to a confined space only after a competent person certifies it in writing as reasonably free of dangerous gas, fume, vapor or dust, or with breathing apparatus and a lifeline held from outside, in addition to testing, ventilation, an attendant and rescue arrangements. 14Boilers Act 2025: boiler certificates for a period not exceeding twelve months. Commencement is by notification. 15
Pharmaceutical (GMP)21 CFR 211.67 requires written procedures for cleaning and maintenance of equipment. 18—EU GMP Annex 15: use quality risk management to evaluate planned changes and plan any requalification. Annex 1 (sterile products): return to use after maintenance should be approved. 16,17

Start-up is a hazard in its own right.

The US Chemical Safety Board found that the March 2005 explosions at the BP Texas City refinery occurred during the restarting of a hydrocarbon isomerization unit. Its recommendations included additional board-operator staffing during start-up, knowledgeable supervisors or technically trained personnel present during especially hazardous phases such as start-up, and start-up procedures updated to reflect actual process conditions. 12

Rules for the Gulf and other regions are not covered here. Always check the law that applies where the plant is located. More: Work permits during shutdowns · Safety incidents during shutdowns.

Tools

How does a CMMS help manage a shutdown?

Software such as a CMMS holds the asset, work order, spares and permit records a shutdown depends on, and can plan, track and close out the work orders in the shutdown scope. MaintWiz adds IoT and predictive maintenance data to that picture. For very large events, planners may also use specialist scheduling tools alongside it.

MaintWiz: executive overview with project health matrix and decisions waiting

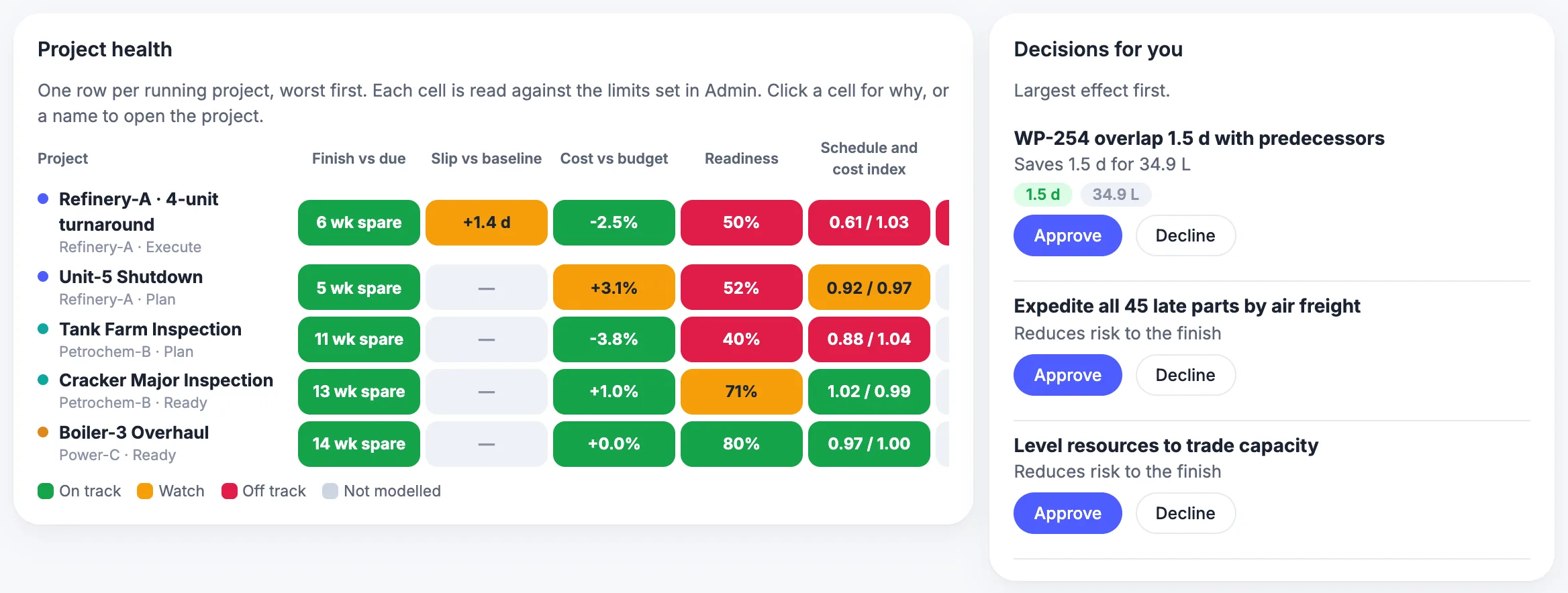

Executive project health. Health of each project and the decisions waiting.
MaintWiz: central planner day view with projects by phase and the critical path in time

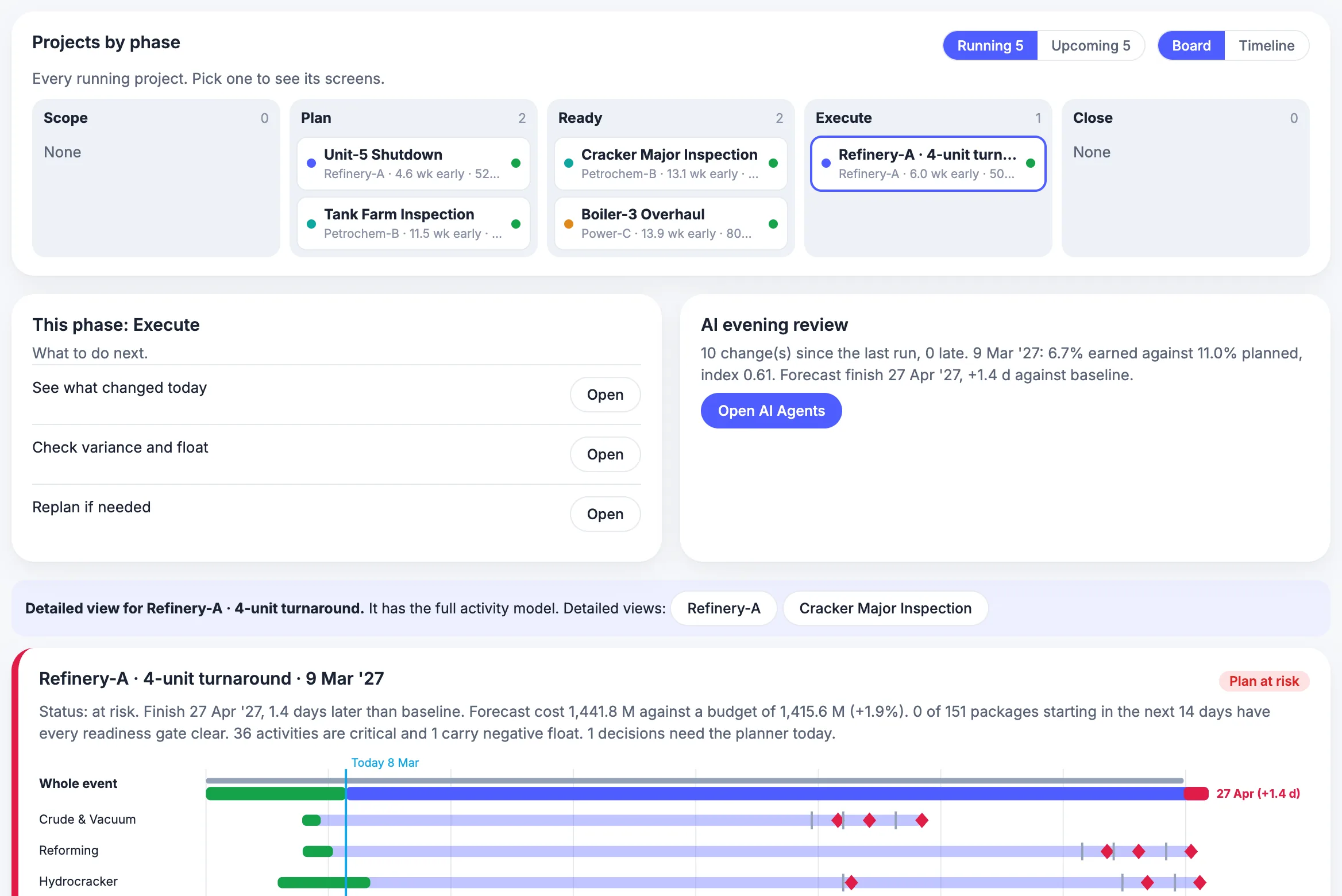

Central planner's day view. What the planner needs today, by project phase.

For how a shutdown module differs from a CMMS and from Primavera P6, see shutdown software vs CMMS vs Primavera P6 and what to digitize first.

About MaintWiz. MaintWiz is an industrial AI platform with IoT, SAP integration and predictive maintenance (PdM) capabilities. Its shutdown and turnaround module helps plants plan, schedule, execute and close out shutdown work.

Also: product data sheet.

What the shutdown module covers

As described on the MaintWiz shutdown maintenance product page.

  • Shutdown calendar and critical-path scheduling, with work order sequencing and dependencies
  • Asset prioritization, so the most critical equipment is scoped first
  • Resource planning for people, spares, heavy equipment such as cranes, and outsourced vendors
  • Electronic permits to work, risk management and contingency plans
  • Real-time progress monitoring: schedule adherence, cost variance, quality metrics and risk factors
  • Step-by-step checklists, pre-restart testing protocols and post-shutdown analysis

Visuals

Every calculator is listed on the shutdown calculator tools page and the files on the shutdown planning templates page.

Save the shutdown maintenance charts

Four one-page charts from this guide. Click any to see it full size.

FAQ

Frequently asked questions

Is shutdown maintenance the same as a turnaround?

Not exactly. A turnaround is usually the large, planned, periodic form of shutdown: EIA defines a refinery turnaround as a planned, periodic shutdown of one or more processing units for maintenance, inspection and repair, and also describes planned, targeted shutdowns of smaller scope. Many plants use the two words interchangeably, so state the scale and duration when you use either. 1

Is a plant outage the same as shutdown maintenance?

No. An outage is any period when a plant or unit is out of service, and it can be planned or unplanned. AFPM describes turnarounds as planned and unplanned outages as shorter stops for specific problems, while NERC's generator reporting rules separate planned, maintenance and unplanned (forced) outages. 2,5

What is an annual shutdown?

An annual shutdown is a planned shutdown scheduled once a year. Plants often place it in a low-demand period, as US refiners and generators do in spring and fall, but its length and scope depend on the equipment, regulation and production calendar. No public benchmark applies across industries. 2,3

How often should a plant shut down for maintenance?

It depends on the equipment, inspection and legal requirements, and the production calendar. EIA says routine turnarounds on key US refinery fuel-production units are planned every 3 to 5 years, and US reactors typically refuel after about 18 or 24 months. Treat these as published examples, not targets for other industries. 1,4

How long does a shutdown take?

It depends on scope. EIA says a refinery unit can be offline for several weeks to several months, and AFPM gives the same range of weeks to months. EIA reports recent US nuclear refueling outages averaging 34 to 38 days, and one German blast furnace reline was reported at 70 days in 2008. 1,2,4,19

How far in advance should a shutdown be planned?

For large events, years ahead: EIA says refinery turnarounds may involve 1 to 2 years of advance planning, and AFPM says planning teams often begin years ahead. Smaller shutdowns need less lead time, but the scope, materials and contractors still have to be settled before the stop. 1,2

What happens to work that is found during the shutdown?

It is assessed, prioritized and, if approved, added to the plan through change control. NERC's generator reporting rules draw the same line: time spent on in-scope inspection is a planned extension, while repairs to damage found during the inspection are coded as forced outage time, and discovery work is outside the original scope of work. Fixing the planned scope early makes extra work visible. 5

Do shutdowns need work permits and lockout?

Where the work is covered by the relevant rules, yes. In the US, OSHA 1910.147 requires an energy control program for servicing and maintenance and 1910.146 requires an entry permit for permit-required confined spaces; the UK, EU and India have their own rules. Check the requirements where the plant is located. 9,10,8,14

Can a CMMS manage a shutdown?

A CMMS can plan, schedule, track and close out the work orders in the shutdown scope and hold the supporting asset, spares and permit records. Very large, multi-contractor events may also use specialist scheduling software alongside it. See the MaintWiz shutdown and turnaround module.

Product questions: MaintWiz shutdown maintenance FAQ.

Sources

Sources

Every figure on this page comes from the public sources below. Most sources describe US refining and power generation; other industries and jurisdictions are covered only where a source was found. Figures can change, so check the source before relying on them.

  1. U.S. Energy Information Administration, Refinery Outages: Description and Potential Impact on Petroleum Product Prices
  2. American Fuel & Petrochemical Manufacturers, Refinery turnarounds 101: What are turnarounds and why do we need them? (17 October 2023)
  3. U.S. Energy Information Administration, Seasonal maintenance helps keep power online during summer and winter peaks (22 April 2011; ISO New England data)
  4. U.S. Energy Information Administration, Nuclear power plants undergo seasonal scheduled outages (23 May 2011)
  5. North American Electric Reliability Corporation, Generating Availability Data System (GADS) Data Reporting Instructions, effective 1 January 2026
  6. U.S. Department of Energy FEMP / Pacific Northwest National Laboratory, O&M Best Practices: Maintenance Approaches
  7. UK Health and Safety Executive, The safe isolation of plant and equipment (HSG253, 2006)
  8. UK Health and Safety Executive, Guidance on permit-to-work systems: a guide for the petroleum, chemical and allied industries (HSG250, 2005)
  9. OSHA, 29 CFR 1910.147, The control of hazardous energy (lockout/tagout)
  10. OSHA, 29 CFR 1910.146, Permit-required confined spaces
  11. OSHA, 29 CFR 1910.119, Process safety management of highly hazardous chemicals
  12. U.S. Chemical Safety and Hazard Investigation Board, BP America (Texas City) refinery explosion
  13. European Union, Directive 2012/18/EU on the control of major-accident hazards involving dangerous substances (Seveso III), EUR-Lex
  14. Government of India, Ministry of Labour and Employment, The Factories Act, 1948
  15. Government of India, The Boilers Act, 2025 (Act No. 12 of 2025), Gazette text as published by PRS India
  16. European Commission, EU GMP Annex 15: Qualification and Validation (2015)
  17. European Commission, EU GMP Annex 1: Manufacture of Sterile Medicinal Products (2022)
  18. eCFR, 21 CFR 211.67, Equipment cleaning and maintenance
  19. Association for Iron & Steel Technology, ThyssenKrupp Steel to Restart Blast Furnace 1 at Duisburg-Schwelgern (20 March 2008)
  20. Publications Office of the European Union, An in-depth study into prolonging blast furnace campaign life (2001)

Move your shutdown plan out of spreadsheets

Book a demo and bring the spreadsheet you use today. We will show how the module covers the same ground.

Book a demo
