Mining Shutdown Planning: Mill Reline and Processing

Short answer

In a mining and mineral processing plant the biggest shutdown job is usually a grinding mill reline, so the plan is built around that job: remove the worn liners, install new ones, and finish all other work in parallel before ramp-up. The critical path runs through the reline, and the other jobs fit inside its float.

How MaintWiz helps: Mill relines and crusher stops depend on crews, parts and access. The MaintWiz shutdown module gives plant teams one plan for scope, schedule, permits, spares and execution, from the first work package to close-out. See the module · Get the data sheet

By · Published · Last reviewed

What MaintWiz adds:Scope, schedule and permits in one planSpares status with SAPReadiness gatesFindings to the planner

Fact block

What do public sources say about mining and mineral processing shutdowns?

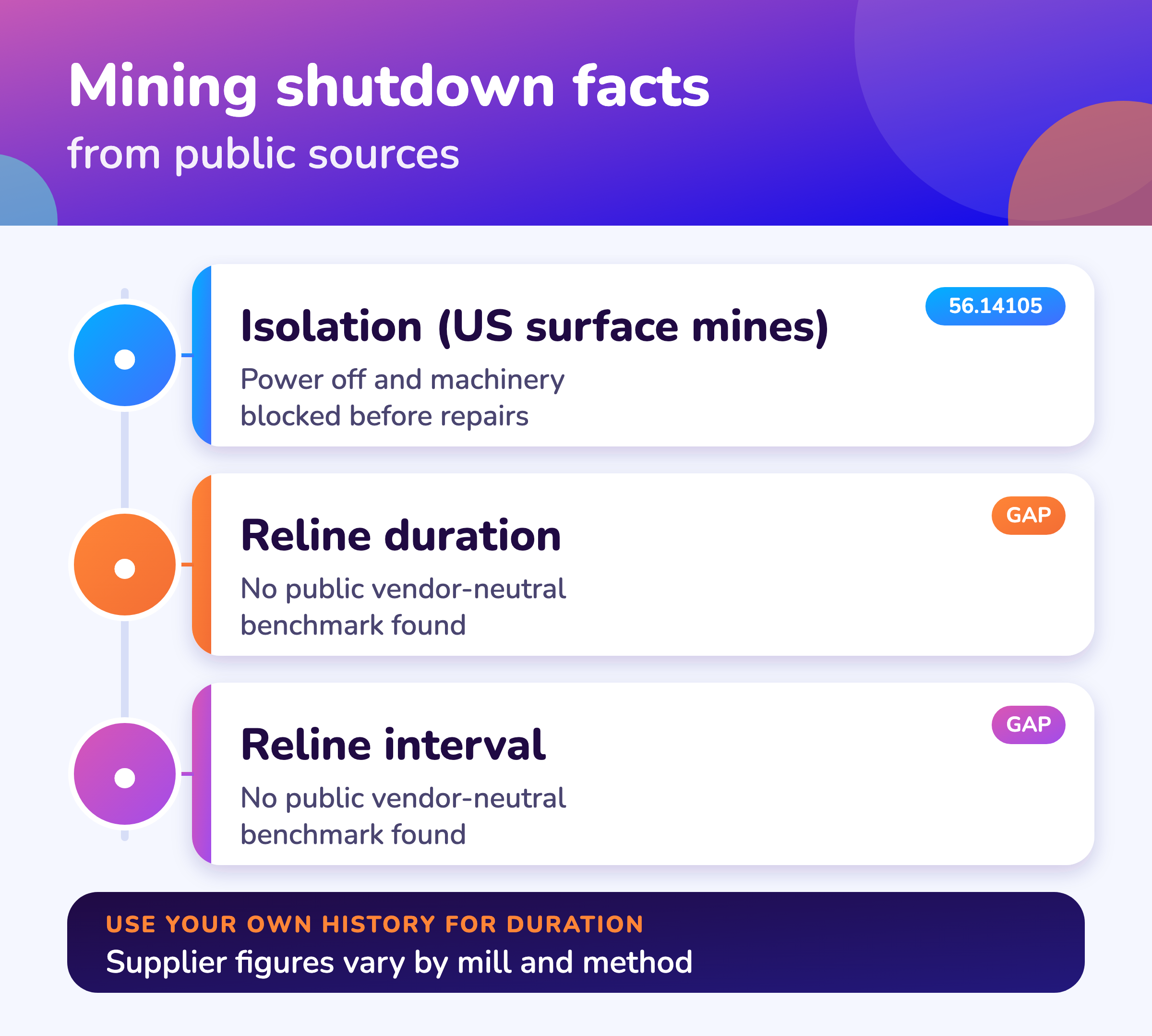

Public sources give little shutdown-specific data for mining: US surface mines must have power off and machinery blocked before repairs, and no vendor-neutral benchmark for mill reline duration or interval was found. 1

Mining shutdown facts with sources
ItemWhat public sources saySource
Usual termShutdown, plant shutdown or maintenance shutdown; for grinding mills, a reline or liner change. No standard definition foundSearched; see sources
Machinery repair (US surface metal and nonmetal mines)Repairs or maintenance are done only after the power is off and the machinery is blocked against hazardous motion; equipment may be run for adjustment or testing only where that cannot be done otherwise, and then with effective protection from hazardous motion (30 CFR 56.14105)30 CFR 56.14105
Electrical work (US surface mines)Electrically powered equipment is deenergized before mechanical work is done on it; power switches are locked out or other measures taken, and warning notices are posted and signed by those who will do the work (30 CFR 56.12016)30 CFR 56.12016
Power circuits (US surface mines)Power circuits are deenergized before work, with switches locked out or other measures taken; locks, signs or devices are removed only by the person who installed them or by authorized personnel (30 CFR 56.12017)30 CFR 56.12017
Schedule logic and floatThe GAO guide describes the critical path as the longest continuous sequence of activities and float as the time an activity can slip without delaying the finishGAO schedule guide
How long a mill reline takesNo public, vendor-neutral benchmark found. Duration figures that exist come from equipment suppliers or single sites and vary by mill size and method, so none is used hereSearched; see sources
Interval between relinesNo public, vendor-neutral benchmark found; it depends on the ore, the mill and the liner designSearched; see sources

Read with care. 30 CFR 56.14105 covers US surface metal and nonmetal mines; other mine types and countries have their own rules. Check the regulator that applies to your site.

Mill reline

What does a mill reline shutdown look like on the schedule?

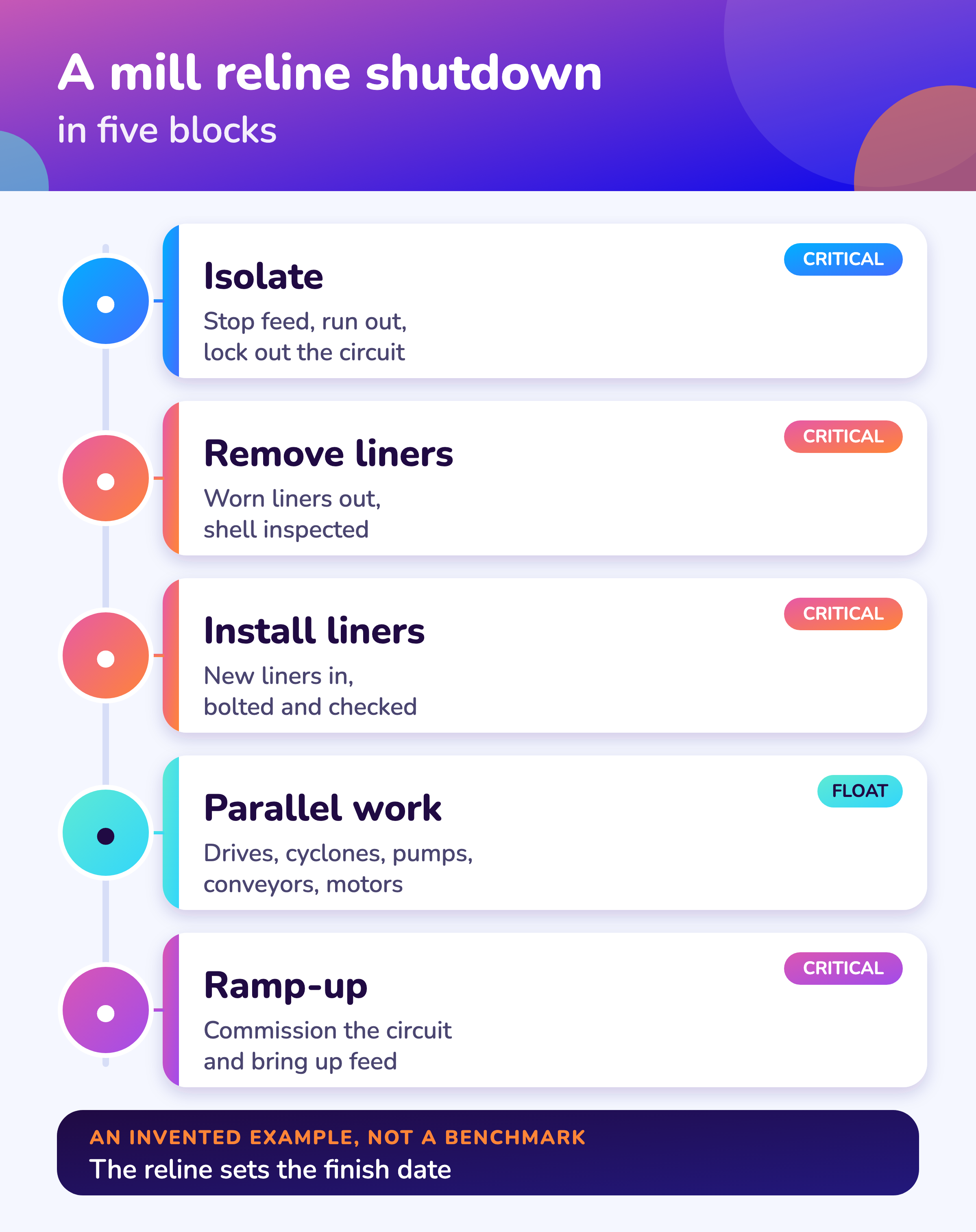

A mill reline shutdown puts the liner removal and installation on the critical path and fits the other plant jobs into their float, then commissions the circuit once all of them are done. 4

The float arithmetic is in critical path vs critical chain; terms are in the shutdown turnaround glossary. A free Excel version is available: Mining mill reline shutdown checklist (.xlsx). A free Excel version is available: Mill reline plan (.xlsx).

Illustrative 18-day concentrator reline schedule (invented example)
IDWork packageCrewDaysOn the path?
MN-101Stop feed, run out and isolate the grinding circuitOperations2Critical
MN-102Remove worn mill linersReline crew5Critical
MN-103Install new mill linersReline crew8Critical
MN-104 to 110Parallel work: ball mill drive, cyclones, pumps, conveyors, motors, crusherMechanical, electrical, crusher crew5 to 7 each6 to 11 days of float
MN-111Commission the circuit and ramp upOperations3Critical

Software

Can software help with a mining shutdown?

Software can hold the reline and the parallel jobs in one schedule with float, track liner and part readiness, and keep isolations and permits with each work package.

About MaintWiz. MaintWiz is an industrial AI platform with IoT, SAP integration and predictive maintenance (PdM) capabilities. Its shutdown and turnaround module helps plants plan, schedule, execute and close out shutdown work.

Also: product data sheet.

What the shutdown module covers

As described on the MaintWiz shutdown maintenance product page.

  • Shutdown calendar and critical-path scheduling, with work order sequencing and dependencies
  • Asset prioritization, so the most critical equipment is scoped first
  • Resource planning for people, spares, heavy equipment such as cranes, and outsourced vendors
  • Electronic permits to work, risk management and contingency plans
  • Real-time progress monitoring: schedule adherence, cost variance, quality metrics and risk factors
  • Step-by-step checklists, pre-restart testing protocols and post-shutdown analysis

Roles

What does a shutdown planner do at a mine?

A shutdown planner at a mine turns the scope into work packages, links them into a schedule with float, books crews, liners and lifting gear, and reports progress against the baseline to the shutdown manager. 4

The role works with the maintenance superintendent, operations and the contractor who supplies the reline crew. For role definitions see shutdown team roles and RACI, and for the package format see shutdown work packages.

Checklist

What belongs on a mill reline checklist?

A mill reline checklist should cover isolation and blocking against motion, control of the barring arrangement, confined space entry, lifting, liner and tool readiness, the critical path and float, the crew plan and the restart plan.

A download is available with the free shutdown templates.

Mill reline shutdown checklist with the basis for each check
CheckBasis
Mill drive, feed and water isolated, locked and tagged30 CFR 56.14105: power off and machinery blocked against motion
Barring or inching arrangement controlled during the work30 CFR 56.14105
Confined space entry plan for the mill shellSite procedure and applicable regulator
Lift plan and liner handler checked before useSite procedure; heavy liners
Liner set and handling tools on site before the stopMaterial readiness; see spare parts guide
Critical path and float known for the reline and parallel workGAO guide terms
Crew and shift plan confirmed for the relineResource loading
Restart and ramp-up steps agreed with operationsPlant restart plan
Mill drive and feed equipment deenergized and locked out before mechanical work; warning notices signed30 CFR 56.12016
Lockout devices removed only by the person who applied them or by authorized personnel30 CFR 56.12017

A working template pending review by a mining engineer. The general list is the 40-step shutdown checklist. This is not regulatory advice.

Visuals

Save the mining shutdown charts

Two charts for the maintenance planning meeting. Click either for the full-size image.

FAQ

Frequently asked questions

What is a mill reline?

The replacement of worn liners inside a grinding mill. It is usually the largest and longest single job in a mineral processing shutdown.

How long does a mill reline take?

There is no published benchmark. Duration varies with mill size, liner design and crew, so plan it from your own history.

How often should a mill be relined?

There is no published benchmark. It depends on the ore, the mill and the liner design.

Do electrical lockout rules apply?

For US surface mines, 30 CFR 56.12016 requires electrically powered equipment to be deenergized before mechanical work, and 56.12017 limits who can remove locks and signs from power circuits. 2,3

Do isolation rules apply?

For US surface metal and nonmetal mines, 30 CFR 56.14105 says repairs and maintenance are done after the power is off and machinery is blocked against hazardous motion. 1

What is on the critical path of a reline shutdown?

Usually the liner removal and installation, with the other jobs in their float. 4 See critical path and float.

Who plans a mining shutdown?

A shutdown planner working with the maintenance superintendent, operations and contractors; see the team roles guide.

Does this cover underground mines or other countries?

No. Check the regulator and standards that apply to your site.

Is the schedule on this page real?

No. It is an invented example to show how the critical path sits on a reline.
