Shutdown types

Types of Shutdown Maintenance: Planned to Statutory

Short answer

Plant shutdowns can be classified three ways: by trigger (planned, statutory, seasonal or emergency), by extent (partial or full plant) and by scale (routine shutdown or turnaround). One event has one value on each axis, for example a planned, partial, routine shutdown, or an emergency, full-plant shutdown.

A shutdown is the stop itself; shutdown maintenance is the work done during it.

How MaintWiz helps: Each type of stop needs scope, schedule, permits and parts under control. The MaintWiz shutdown module moves the plan from spreadsheets into one system with a critical path, readiness gates, permits and spares status. See the module · Get the 40-step checklist

By · Published · Last reviewed

What MaintWiz adds:Critical path and floatReadiness gatesPermits and isolationsSpares status with SAP

By trigger

What are the types of shutdown by trigger?

The types of shutdown by trigger are planned, statutory (or inspection-driven), seasonal and emergency (or forced). The trigger tells you who sets the date: management, a regulation, the demand cycle, or an event.

Plant workers at a planned maintenance work-package board beside an emergency shutdown sign, turnaround site behind
Illustration (synthetic image): The same plant can face a planned stop, an emergency stop and a turnaround. The trigger decides how much notice there is and who sets the date.

A planned stop is the usual setting for shutdown maintenance; the other three change how much notice you have or who controls the date.

Planned

Scheduled in advance, with scope, budget and resources set before the stop. In US refining, EIA says turnarounds may involve 1 to 2 years of advance planning. 1,3

Statutory or inspection-driven

The date is set by law or an inspection scheme. In Great Britain a written scheme of examination must be in place before qualifying pressure equipment is used, and examinations follow it. 4,5 In India a boiler certificate authorizes use for no more than twelve months (Boilers Act 2025, section 12(6)); the Act commences on a date the central government notifies. 6 The Factories Act (replaced by the OSH Code, 2020 from 21 November 2025) lets state governments make rules for examining and testing pressure plant (section 31(2)). 7

Seasonal or low-demand window

Timed for the season when demand is lowest: spring or fall in US refining, and spring and fall for generators in the New England data EIA analyzed. 2,8

Emergency or forced

Not scheduled. EIA describes emergency shutdowns where a unit or the whole refinery must come down immediately, without warning. Power generation grades forced outages by urgency; see turnaround vs shutdown vs outage. 1

What sets the date

What sets the date for each trigger type
TriggerWhat sets the datePlanning lead timeSource
PlannedManagement, in line with equipment condition and the production calendarRefinery turnarounds: 1 to 2 years of advance planning. No public figure for other sectorsEIA
Statutory or inspection-drivenA legal inspection or certificate date, or an inspection schemeKnown from the certificate or scheme interval, so planning can start earlyHSE PSSR, Boilers Act 2025
Seasonal or low-demand windowThe demand cycleSet by the season; spring or fall in US refining and generationAFPM, EIA
Emergency or forcedAn event: a failure, trip or hazardNone; the unit comes down immediately (emergency) or within a defined period (forced)EIA, NERC GADS

By extent

Partial or full-plant shutdown?

A partial shutdown stops part of the plant; a full-plant shutdown stops all of it. The difference that matters most in practice is the isolation boundary between the work area and anything still live.

Treatment plants that isolate one unit at a time are covered in water and wastewater plant outages. Planned outages at nuclear plants are covered in nuclear refueling outage planning.

Partial or targeted

One or more units, or a smaller scope, come out of service while the rest runs. EIA describes planned, targeted shutdowns of smaller scope than a turnaround. 1

Full plant

The whole plant or refinery is out of service. EIA defines a turnaround as covering one or more units, or possibly the entire refinery. 1

HSE guidance describes boundary isolation with fully rated spades or blinds at the plant boundary, typically used on maintenance shutdowns or turnarounds where hazardous inventory is removed, to prevent re-pressurization from, or ingress from, adjacent live systems. 9 In a partial shutdown, that adjacent live plant is the main hazard to plan around.

Software

Does the type of shutdown change what you need to manage it?

No, the type of shutdown does not change what you need to manage it. Each type still needs a scope, a schedule, permits, spares and a close-out. The type only changes how early you can plan.

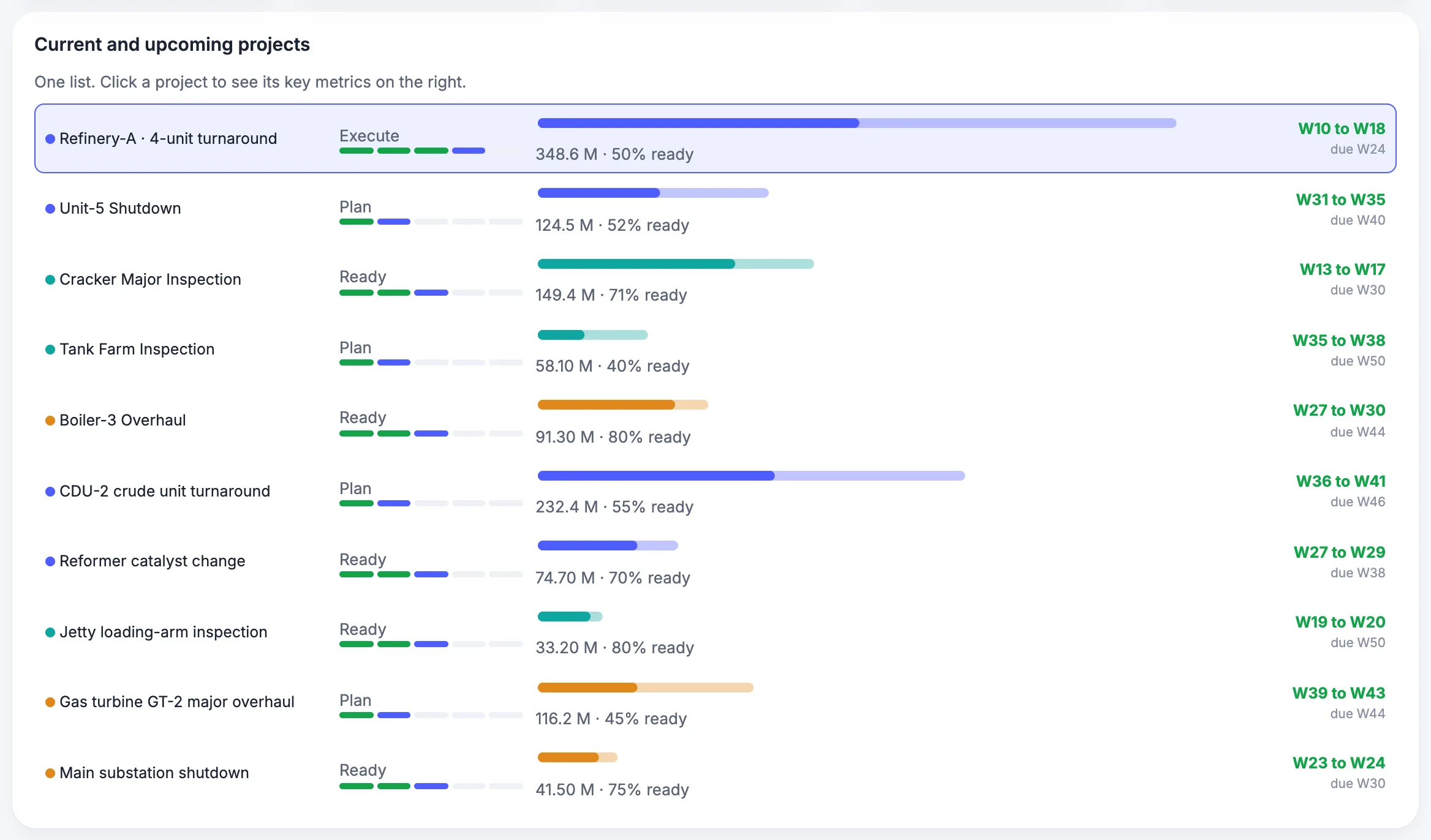

MaintWiz: table of current and upcoming shutdown projects with key measures
Current and upcoming projects table. Every project with its dates and status.

See the shutdown management software overview for portfolio and project views.

About MaintWiz. MaintWiz is an industrial AI platform with IoT, SAP integration and predictive maintenance (PdM) capabilities. Its shutdown and turnaround module helps plants plan, schedule, execute and close out shutdown work.

Also: product data sheet.

What the shutdown module covers

As described on the MaintWiz shutdown maintenance product page.

  • Shutdown calendar and critical-path scheduling, with work order sequencing and dependencies
  • Asset prioritization, so the most critical equipment is scoped first
  • Resource planning for people, spares, heavy equipment such as cranes, and outsourced vendors
  • Electronic permits to work, risk management and contingency plans
  • Real-time progress monitoring: schedule adherence, cost variance, quality metrics and risk factors
  • Step-by-step checklists, pre-restart testing protocols and post-shutdown analysis

By scale

Routine shutdown or turnaround?

A turnaround is the large, periodic, planned form of shutdown; a routine shutdown is smaller and more frequent. The published numbers come from US refining, so do not apply them to another sector.

Nuclear refueling outages, a scheduled form of turnaround, are covered in nuclear refueling outage planning.

Routine shutdown compared with a turnaround
QuestionRoutine shutdownTurnaroundSource
What is it?A smaller planned stop; EIA calls these planned, targeted shutdowns of smaller scopeThe large, periodic, planned form of shutdownEIA, AFPM
How often?No public benchmark foundUS refining: routine turnarounds on key units every 3 to 5 yearsEIA
How long?No public benchmark foundUS refining: a unit offline several weeks to several monthsEIA, AFPM
How far ahead is it planned?No public benchmark foundUS refining: 1 to 2 years of advance planningEIA

Full comparison of the words, including outage and overhaul: Turnaround vs shutdown vs outage.

Classify

How do you classify a shutdown?

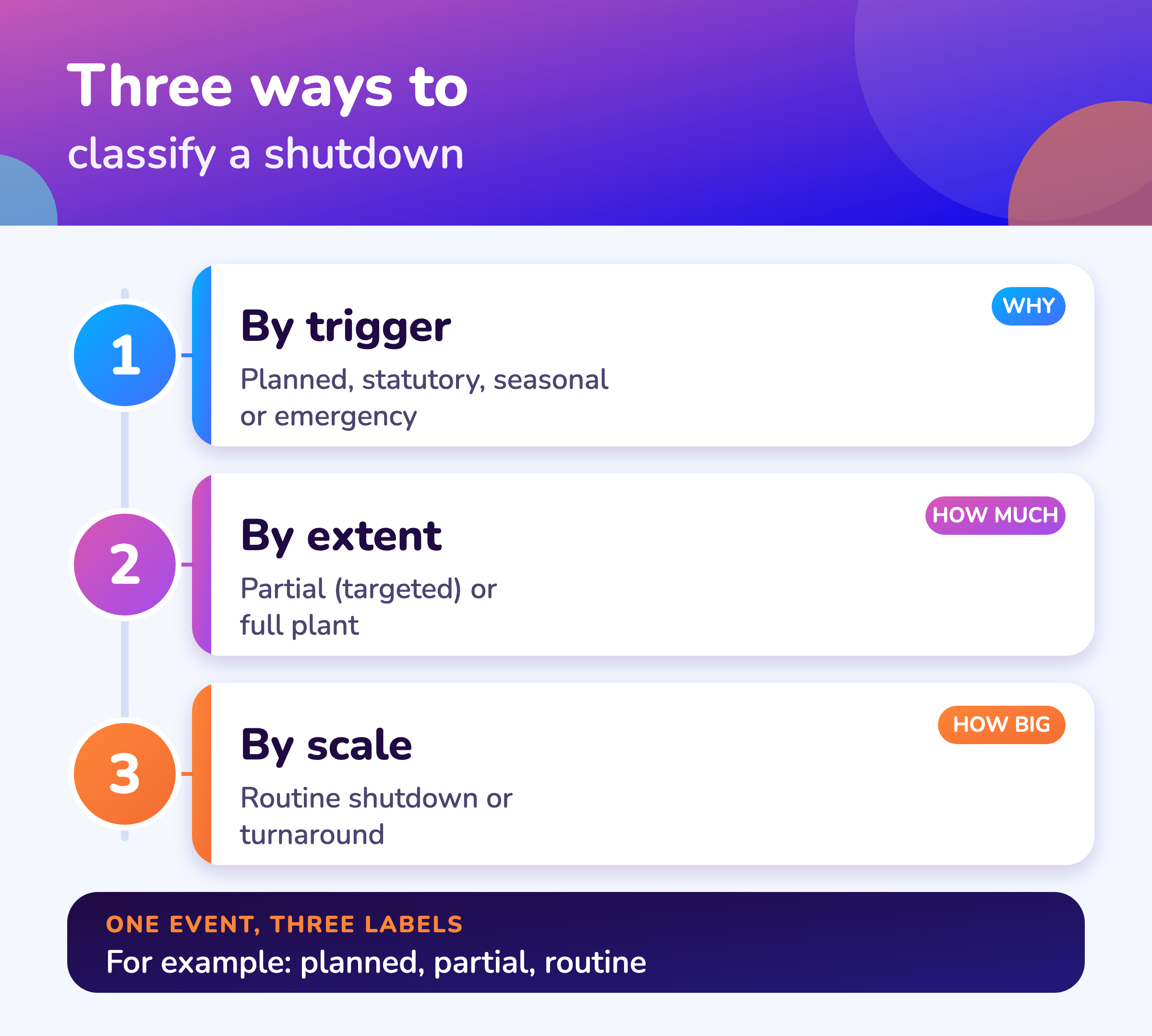

To classify a shutdown, answer three questions, then add scale (routine or turnaround) and season.

For treatment plants that cannot stop, see water and wastewater plant outages.

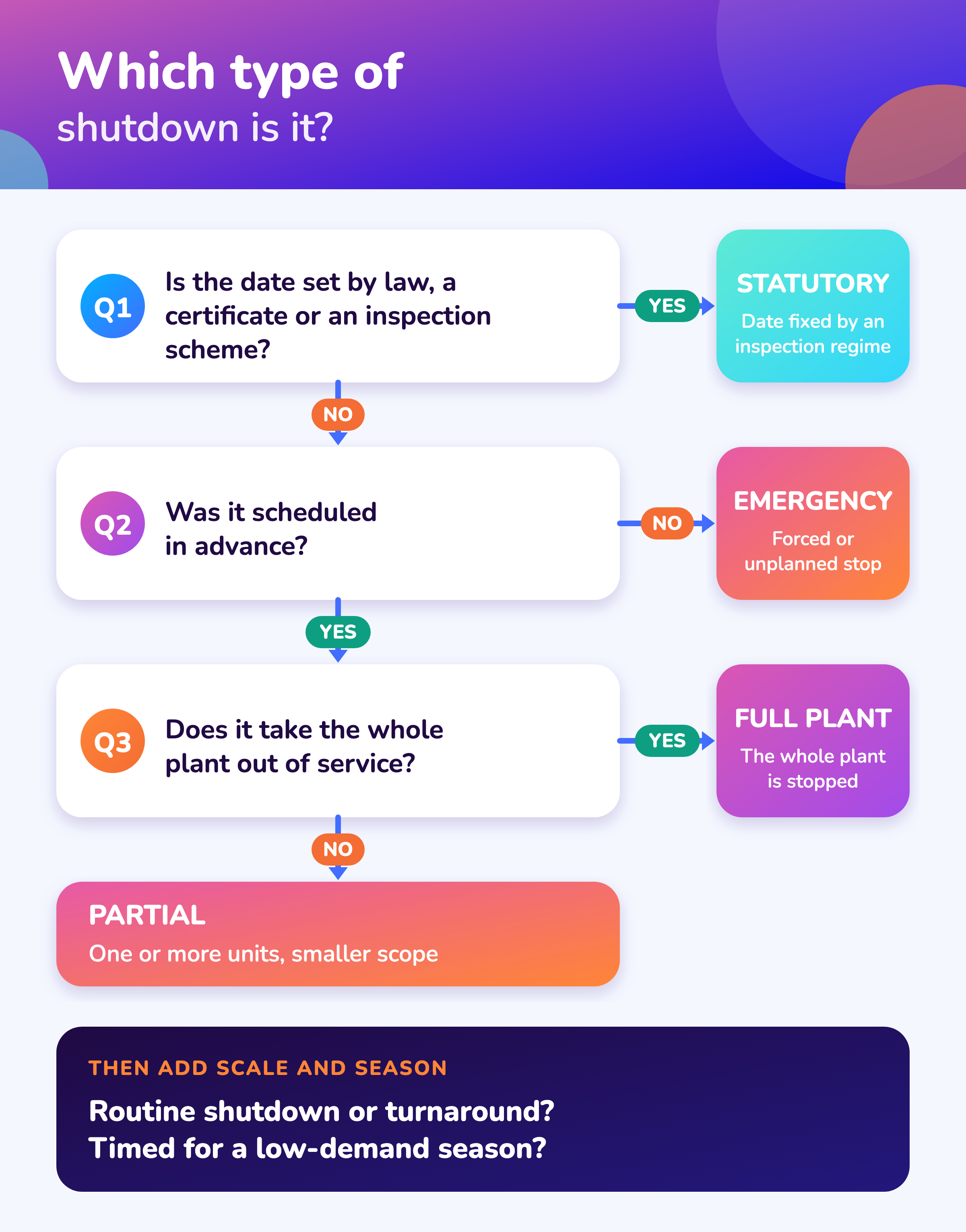

  1. Q1Is the date set by law, a certificate or an inspection scheme?
    YES → STATUTORYBuild the scope around the fixed dateIf no, go to Q2
  2. Q2Was it scheduled in advance?
    NO → EMERGENCY OR FORCEDThe unit comes down without a planIf yes, go to Q3
  3. Q3Does it take the whole plant out of service?
    YES → FULL PLANTThe whole plant is stoppedIf no, it is a partial or targeted shutdown
Then add scale and season: is it a routine shutdown or a turnaround, and is it timed for a low-demand window?

Look-alikes

Terms that are not shutdown types

Hot and cold shutdown (nuclear)

In nuclear regulation these describe reactor states. The NRC glossary describes cold shutdown as a reactor coolant system at atmospheric pressure and below 200 degrees Fahrenheit following a cooldown. They are not maintenance types. 10

The UK pressure systems regulations are explained in PSSR pressure systems safety regulations in the UK.

Opportunity maintenance

This guide uses it to mean doing deferred jobs while equipment is already stopped for another reason. No standard definition was found in the public sources reviewed, so check how your site uses the term.

Outage

An outage can be planned or unplanned, so it is not a separate type. See turnaround vs shutdown vs outage.

Planning

How does the type change the plan?

The type of shutdown changes who controls the date and how much notice you have, not whether you need a scope, a schedule, permits and a close-out. The right-hand column is planning guidance, not a sourced benchmark.

The cost effect of each type is in planned vs unplanned shutdown cost.

What each type changes about the plan
TypeWhat changesGuidance
PlannedYou control the date, so scope, materials and contractors can be fixed before the stopFreeze scope, order long-lead items, hold a readiness review. See the planning guide
StatutoryThe date is fixed by the inspection regime, so other work gathers around itBuild the scope backward from the certificate or inspection date; add other deferred work that needs the same stop
SeasonalThe window is fixed by demandTreat the window as a hard end date and size the scope to fit it
Emergency or forcedThere is no time for a normal planKeep a standing list of deferred jobs and a standard isolation and permit routine so the stop is used well
PartialLive plant remains next to the workPlan the isolation boundary first
TurnaroundLong lead times and many contractorsUse change control for any modification, and plan restart as carefully as shutdown

Next: How to plan a plant shutdown · When to schedule shutdowns · Shutdown scope · Planned vs unplanned shutdown cost.

Visuals

Save the classification charts

Both charts open full size when clicked, for saving or sharing.

FAQ

Frequently asked questions

What are the main types of plant shutdown?

Three ways of classifying them are common: by trigger (planned, statutory, seasonal or emergency), by extent (partial or full plant) and by scale (routine shutdown or turnaround). One event has one value on each axis. 1,2,3

What is the difference between a planned and an emergency shutdown?

A planned shutdown is scheduled in advance with its scope set beforehand. An emergency shutdown brings a unit or the whole refinery down immediately, without warning. 1,3

What is a statutory shutdown?

A statutory shutdown is one whose date is set by law or an inspection scheme, for example a boiler certificate or a pressure-system examination. In Great Britain a written scheme of examination must be in place before qualifying pressure equipment is used. 4,6

What is a partial shutdown?

A partial or targeted shutdown takes one or more units, or a smaller scope, out of service while the rest of the plant runs. The isolation boundary between the work area and live plant is the main planning concern. 1,9

Is a turnaround a type of shutdown?

Yes. A turnaround is the large, planned, periodic form of shutdown, usually covering one or more units or possibly the whole plant. 1,2

Can a shutdown be planned and statutory at the same time?

Yes. The trigger types are not exclusive: a statutory inspection date can be the reason for a planned shutdown, and the stop can also be a seasonal window or a turnaround.

What are hot shutdown and cold shutdown?

In nuclear regulation they describe reactor states, not maintenance types. The NRC glossary describes cold shutdown as a reactor coolant system at atmospheric pressure and below 200 degrees Fahrenheit following a cooldown. 10

How often does each type happen?

There is no cross-industry figure. In US refining, EIA says routine turnarounds on key units are planned every 3 to 5 years. For other sectors there is no published benchmark. 1
