Plant Start-Up After Shutdown: Restart Checks and PSSR

Short answer

Before a plant restarts after a shutdown, someone with authority should confirm that equipment matches specification, procedures and training are in place, isolations are removed in order, known defects are cleared and the right people are in the unit. OSHA's pre-startup safety review formalizes the first of these checks for covered processes.

Restart is the second half of phase 4 in the five-phase model, followed by close-out and review.

How MaintWiz helps: Quality problems start when a package begins before it is ready. The MaintWiz shutdown module checks seven readiness gates before a package starts and records waivers with a typed reason, name and date. See the module · Get the readiness checklist

By · Published · Last reviewed

What MaintWiz adds:Seven readiness gatesSigned waivers with name and dateKeyboard operationLook-ahead by gate

The gate

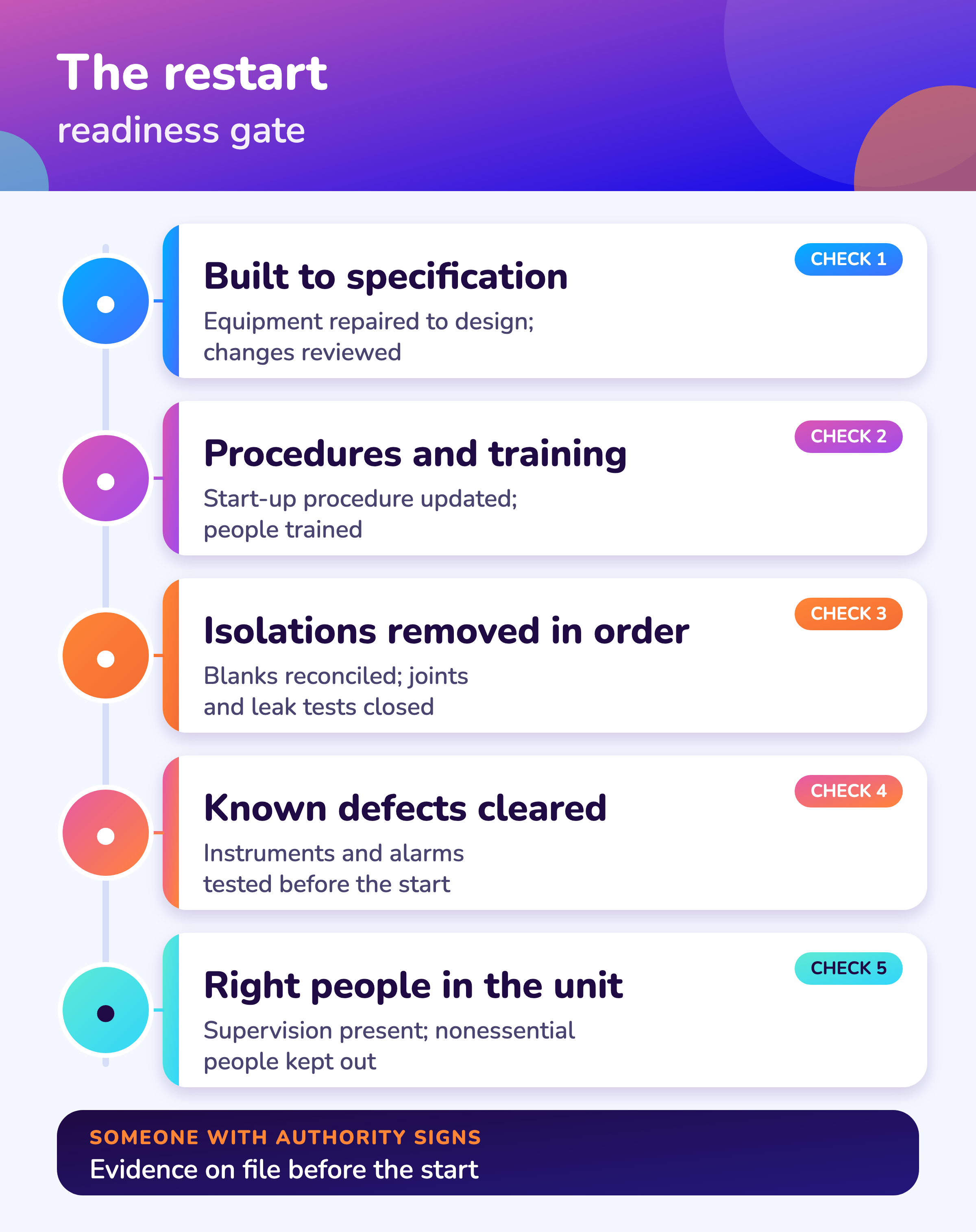

What must be checked before a plant restarts after a shutdown?

Before a plant restarts, someone with authority should confirm that equipment is built and repaired to specification, procedures and training are in place, isolations are removed in order, known defects are cleared and the right people are in the unit. Under OSHA's process safety standard, a pre-startup safety review confirms the first items before hazardous chemicals are introduced. 1

The OSHA rules that bear on restart are mapped in OSHA PSM turnaround rules. Food plants add a sanitation release: food and beverage plant shutdowns. A free Excel file for this page: restart readiness checklist (US and UK) (.xlsx). The restart gate is one of the seven gates in turnaround readiness review and phase gates.

Restart readiness gate: check, evidence and sign-off
CheckEvidenceSigns offBasis
Equipment built and repaired to specification; changes reviewedInspection and test records; management of change recordsEngineering and operationsOSHA PSSR confirmation OSHA 1910.119
Procedures in place and adequate; people trainedUpdated start-up procedure; training recordsOperations managerOSHA PSSR confirmation OSHA 1910.119
Isolations removed in the planned order; blanks reconciledIsolation certificates closed; blank and blind register balancedOperations and permit authorityHSE HSG253
Disturbed joints, leak tests and valve positions confirmedJoint control and leak-test records; valve position check against the planOperationsHSE HSG253
No isolation tags left; system checked against the P&IDVisual walk-down by operations personnelOperationsHSE HSG253
Known instrument and alarm defects clearedCalibration and function test recordsInstrument leadBP Texas City: started despite reported malfunctions CSB Texas City report
Staffing and supervision for the start-up periodRoster showing extra operators and knowledgeable supervisors present in hazardous phasesPlant managerCSB Texas City recommendations CSB
Nonessential people kept out while hazardous material is reintroducedExclusion zone defined and communicatedOperations and safetyCSB Kuraray report
Return to use approved after maintenance (sterile manufacturing)Qualification and approval recordQuality unitEU GMP Annex 1, EU GMP Annex 15

The sign-off column is a working template; assign roles to match your site. The evidence column follows the cited guidance where a basis is shown.

PSSR

What is a pre-startup safety review?

A pre-startup safety review (PSSR) is a check, required by OSHA for covered processes, that construction and equipment match design, procedures are in place and adequate, any change has been reviewed and training is complete before hazardous chemicals are introduced. 1

The shutdown turnaround glossary lists both meanings of PSSR; the UK meaning is explained in PSSR pressure systems safety regulations in the UK. The UK pressure systems rules are explained in PSSR pressure systems safety regulations.

OSHA's paragraph applies to new facilities and to modified facilities when the modification requires a change in process safety information. 1 A routine shutdown with replacements in kind may not trigger it, but many sites run a restart review anyway because the same questions apply. Where the standard does not apply, the checks above are good practice, not a legal requirement.

Software

Can software support restart checks?

Software can hold the restart checklist, the test records and the sign-offs with the work orders they depend on, so open items are visible before the start-up decision.

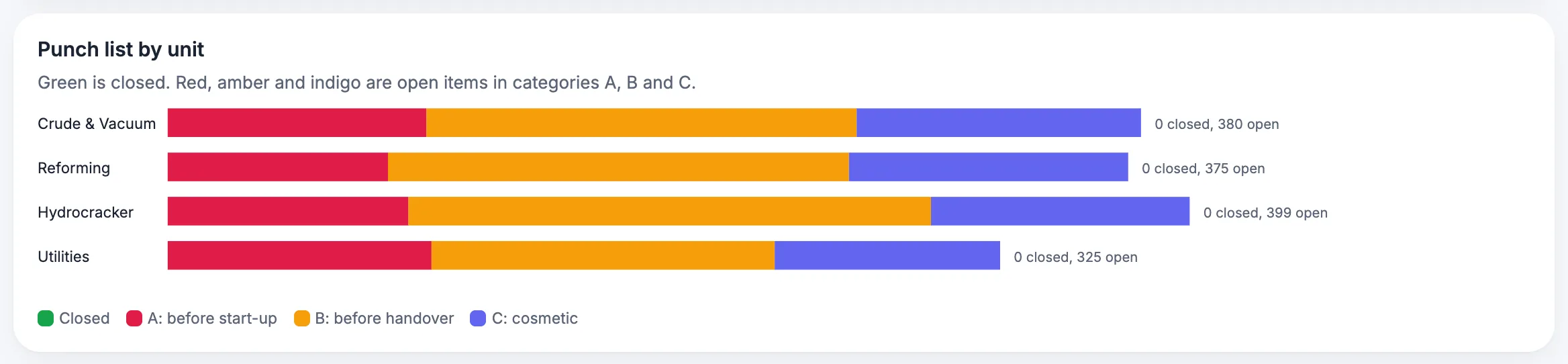

MaintWiz: handover punch list by unit
Handover punch list by unit. Open punch items by unit before handback.

Readiness gates are described in the shutdown management software overview.

MaintWiz analytics dashboards on a laptop and tablet showing sample status and bar charts
Example of MaintWiz analytics dashboards. The charts show sample data for illustration only.

About MaintWiz. MaintWiz is an industrial AI platform with IoT, SAP integration and predictive maintenance (PdM) capabilities. Its shutdown and turnaround module helps plants plan, schedule, execute and close out shutdown work.

Also: product data sheet.

What the shutdown module covers

As described on the MaintWiz shutdown maintenance product page.

  • Shutdown calendar and critical-path scheduling, with work order sequencing and dependencies
  • Asset prioritization, so the most critical equipment is scoped first
  • Resource planning for people, spares, heavy equipment such as cranes, and outsourced vendors
  • Electronic permits to work, risk management and contingency plans
  • Real-time progress monitoring: schedule adherence, cost variance, quality metrics and risk factors
  • Step-by-step checklists, pre-restart testing protocols and post-shutdown analysis

Quality plan

What is an inspection and test plan for a shutdown?

An inspection and test plan lists each quality-critical activity with its acceptance standard, the point where work stops for inspection, who signs and what record is kept, so that defects are found before the restart and not after it.

An inspection and test plan for shutdown work
ActivityAcceptance standardCheck pointWho signsRecord
Reassemble heat exchangerDrawing and torque specificationHold point before closingMechanical supervisor and inspectorTorque sheet
Pressure or leak testTest procedure and pressureWitness pointInspector and operationsTest certificate
Align rotating equipmentManufacturer toleranceWitness pointMechanical leadAlignment report
Instrument loop checkLoop sheetHold point before start-upInstrument lead and operationsLoop check record
Final walk-downP&ID and punch listHold point before releaseOperationsSigned walk-down

The plan format is a working template; no public standard is cited here. Use your site's quality procedure where one exists. Quality in the wider shutdown is part of the five-phase model in the pillar guide.

Why it goes wrong

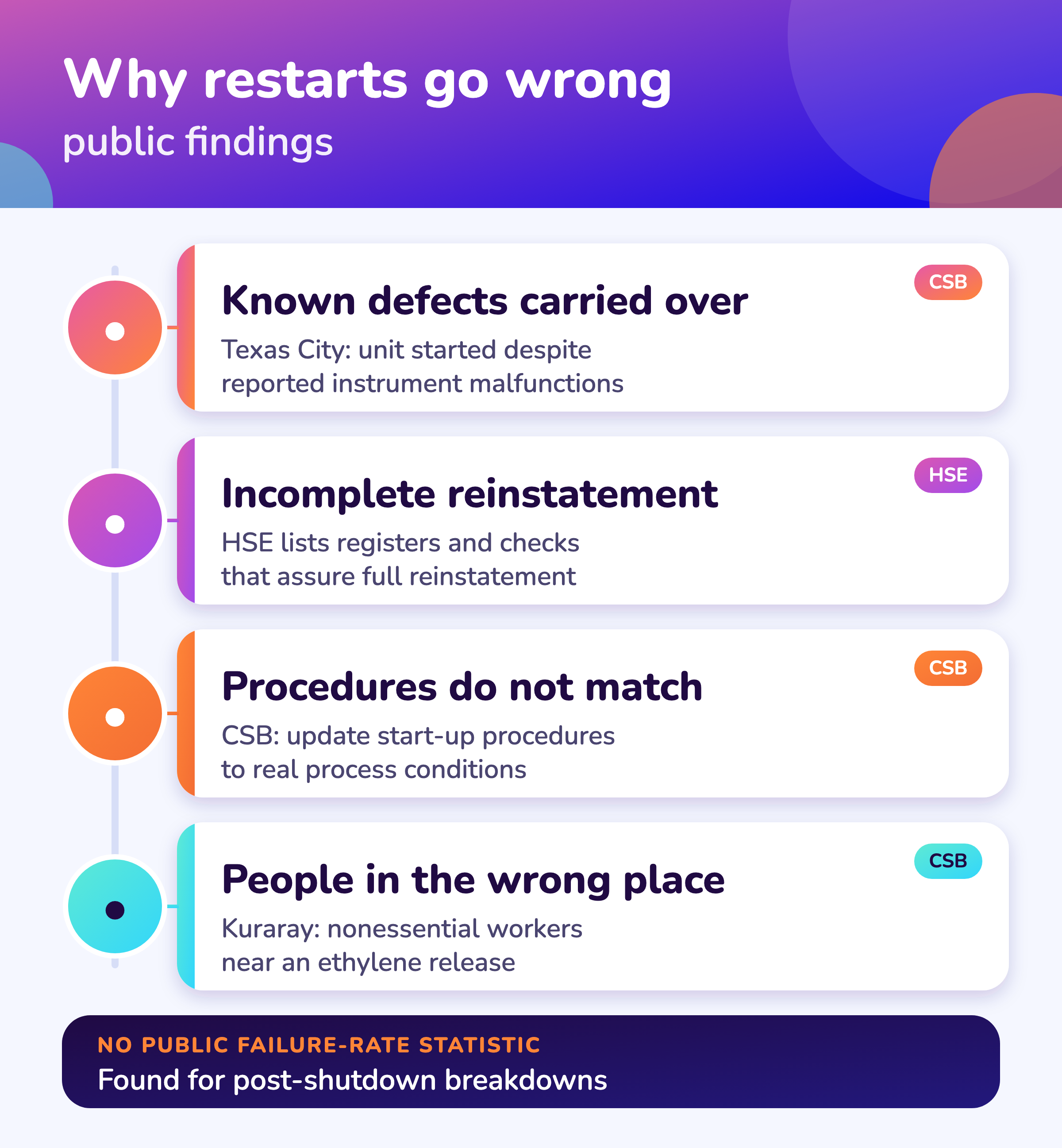

Why do problems appear right after a shutdown?

Public investigations point to four recurring causes: defects carried into the start-up, incomplete reinstatement, procedures that do not match the plant, and people in the wrong place when hazardous material returns. There is no published statistic on early-life failure rates after shutdowns, so this page gives none. 3,2,5

For UK pressure systems and isolation rules see HSG253 safe isolation for shutdowns. Tests before restart are planned in hydrotest and leak test planning.

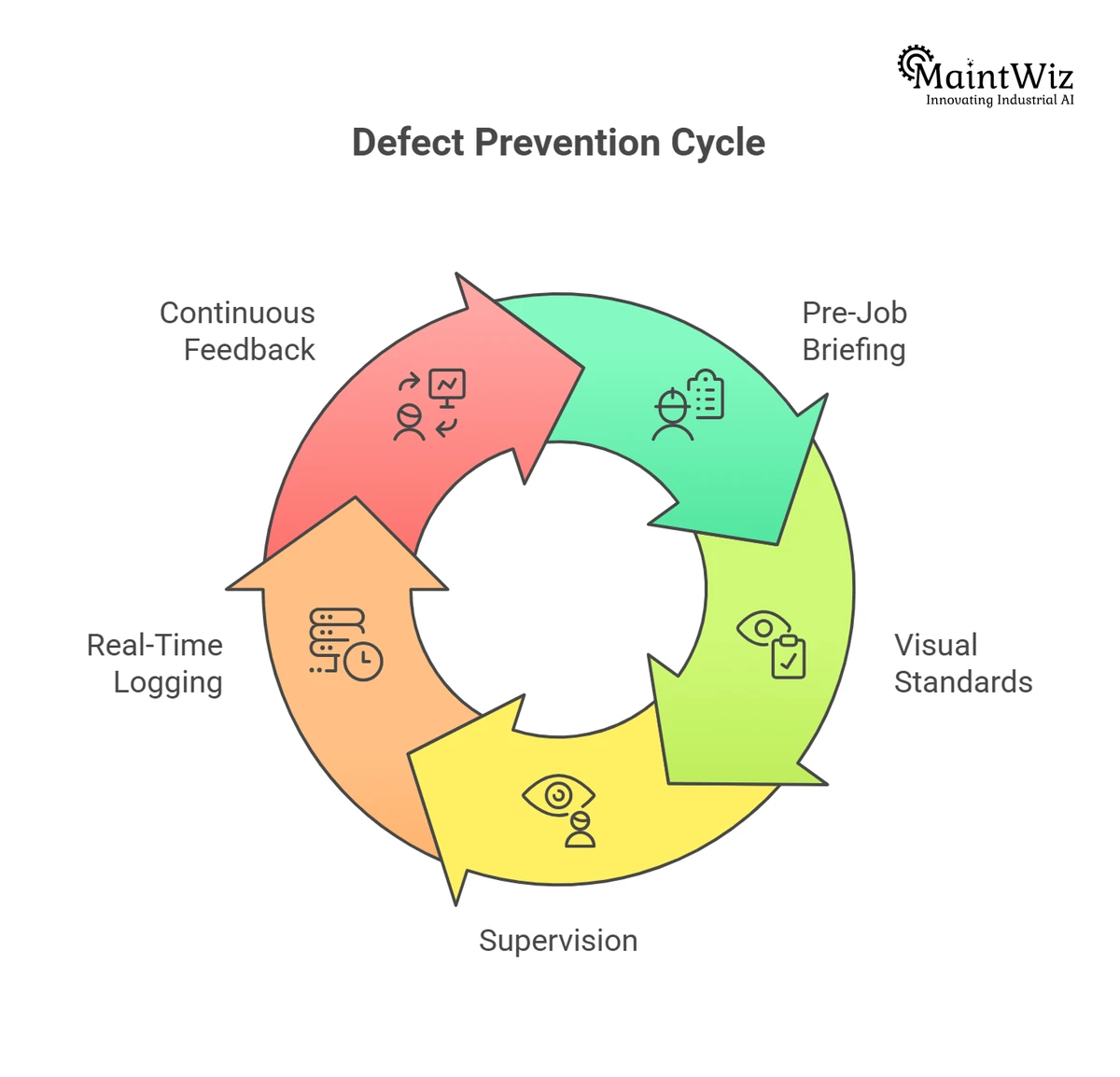

Defect prevention cycle: pre-job briefing, visual standards, supervision, real-time logging and continuous feedback
A defect prevention cycle for shutdown work in five stages: pre-job briefing, visual standards, supervision, real-time logging and continuous feedback. A MaintWiz illustration.

Known defects carried over

At Texas City the unit was started despite previously reported malfunctions of the tower level indicator, a level sight glass and a pressure control valve. 3

Incomplete reinstatement

HSE lists a blank and blind register, control of disturbed joints, leak-test records and a visual check against the P&ID among the systems that assure full reinstatement. 2

Procedures that do not match the plant

The CSB recommended that start-up procedures be updated to reflect actual process conditions, and that knowledgeable supervisors be present in hazardous phases such as start-up. 4

People in the wrong place

In the Kuraray startup after a turnaround, welding by nonessential contractors likely ignited an ethylene release; no formal exclusion zone had been set. 5

The CSB's Husky Superior report also shows that the shutdown can be as hazardous as the restart: most safeguards that keep air and hydrocarbons apart during an FCC unit shutdown were not implemented or not effective. 6 See shutdown safety plan for the full picture.

Handback

How does restart connect to the rest of the shutdown?

Restart is the second half of phase 4, and it starts with the controlled hand back described in shutdown execution, then continues through the checks here and ends with the close-out review in shutdown lessons learned.

For GMP restart rules in pharmaceutical plants, see pharmaceutical plant shutdowns.

Readiness for restart should be planned from the start: the tests, the people and the approvals are part of the schedule in shutdown scheduling, not an afterthought.

Visuals

Save the restart charts

Both charts open full size when clicked, ready for the start-up meeting.

FAQ

Frequently asked questions

What should be checked before restarting a plant after a shutdown?

Equipment built and repaired to specification, procedures and training in place, isolations removed in order, known defects cleared and the right people in the unit. OSHA's pre-startup safety review covers the first group for covered processes. 1,2

What is a PSSR?

A pre-startup safety review: confirmation, before hazardous chemicals are introduced, that construction and equipment match design, procedures are adequate, changes were reviewed and training is complete. 1

Is a PSSR required after every shutdown?

OSHA's paragraph applies to new facilities and to modified facilities where the modification requires a change in process safety information, so a routine shutdown with replacements in kind may not trigger it. Many sites review anyway. 1

How do you assure full reinstatement after isolation?

HSE lists a blank and blind register, control of disturbed joints, purging records, leak testing records and a visual valve and tag check against the P&ID. 2

Why do breakdowns happen right after a shutdown?

Public investigations point to known defects carried into start-up, incomplete reinstatement, procedures that do not match the plant and people in the wrong place. There is no published failure-rate statistic. 3,2,5

Who should be present during a hazardous start-up?

The CSB recommended extra operator staffing and knowledgeable supervisors during start-up, and the Kuraray report found nonessential workers should be excluded when hazardous material is reintroduced. 4,5

What applies to restart in pharmaceutical plants?

EU GMP Annex 1 says return to use after maintenance should be approved, and Annex 15 says to use quality risk management to plan any requalification. 7,8

What is an inspection and test plan?

A list of quality-critical activities with the acceptance standard, hold or witness point, who signs and the record kept. The format on this page is a working template.
