Shutdown Lessons Learned: Process, Agenda and Template

Short answer

A shutdown lesson learned is a good practice or an adverse experience that is captured and shared, so the next stop repeats the good and avoids the bad. This guide gives the five-stage process, three review agendas and a template for the entry.

The review timings and template are working conventions, adapted from the DOE lessons learned process.

How MaintWiz helps: Lessons are lost when they live in a slide deck. The MaintWiz shutdown module keeps handover notes, lessons learnt and deferred items with an archive of past shutdowns. See the module · Get the lessons register

By · Published · Last reviewed

What MaintWiz adds:Handover notesLessons learntDeferred itemsArchive of past shutdowns

Definition

What is a lesson learned in a shutdown?

A lesson learned is a good work practice or an adverse experience that is captured and shared, so that others repeat the good and avoid the bad; the point is the sharing and use, not the record. 1

For why budgets overrun, see why shutdowns go over budget.

The US Department of Energy standard on lessons learned defines a lesson learned as a good work practice or innovative approach that is captured and shared to promote repeat application, or an adverse work practice or experience that is captured and shared to avoid recurrence. 1 For a shutdown that means a finding, a delay, a clever fix or a near miss recorded with enough context that the next planner can act on it. It is step 40 of the 40-step checklist.

The same standard says a lessons learned program has two processes. The development process covers identification, documentation, validation and dissemination. The utilization process covers identifying applicable lessons, distributing them, deciding actions and following up that the actions happened. 1 Many plants do the first and stop; the value is in the second.

Process

How do you run a shutdown lessons learned process?

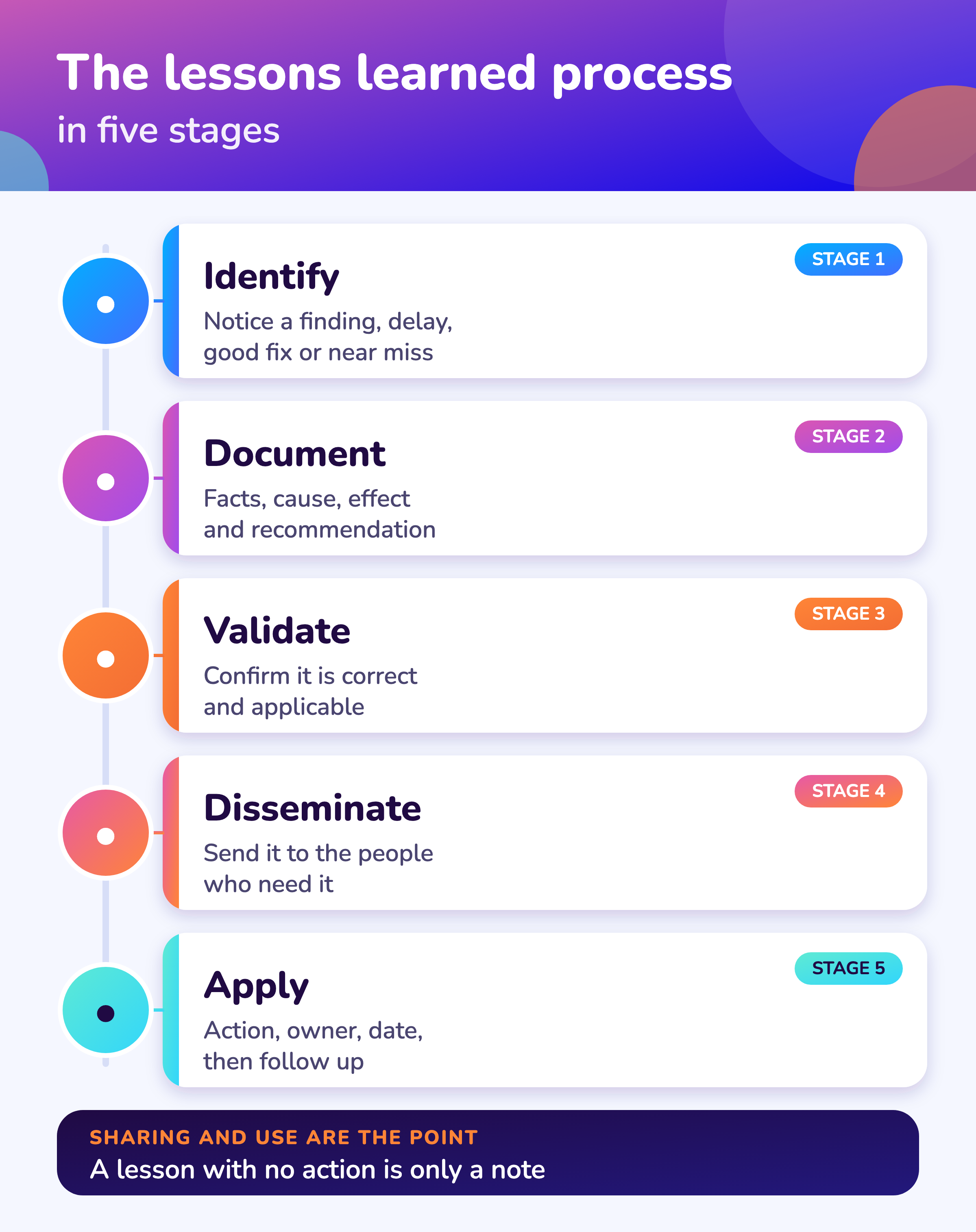

Run the process in five stages: identify the lesson, document it with its context, validate it, disseminate it to the people who need it, and apply it through a named action with an owner and a date. 1

The lessons learned process applied to a shutdown
StageWhat it meansIn a shutdown
IdentifyNotice something worth sharingDaily meeting actions, findings, delays, near misses, punch items, contractor feedback
DocumentWrite it with its contextTemplate entry with the job, the cause, the effect and the recommendation
ValidateCheck that it is correct and applicableShutdown manager and the owner confirm the facts and the cause
DisseminateSend it to the people who need itPlanners, area leads, contractors and the next stop team
ApplyDecide actions and follow upUpdate job plans, checklists, scope, estimates and the risk register; assign an owner and a date

The DOE standard also asks that the way of raising a lesson be simple, that lessons carry the context in which they were learned, and that there be no stigma or blame for the person who raises one. 1 That matters on a shutdown, where contractors and operations staff may hesitate to report their own errors.

The five-stage table is our adaptation of the DOE process to shutdowns, not DOE wording.

Software

Can software capture shutdown lessons?

Software helps most at the capture stage: findings, as-left notes and baseline changes are recorded as the work happens, so the review starts from data instead of memory.

About MaintWiz. MaintWiz is an industrial AI platform with IoT, SAP integration and predictive maintenance (PdM) capabilities. Its shutdown and turnaround module helps plants plan, schedule, execute and close out shutdown work.

Also see shutdown KPIs.

What the shutdown module covers

As described on the MaintWiz shutdown maintenance product page.

  • Findings sent to the planner from the work order, with the cause and the effect
  • Handover note and as-left summary on each work order
  • Close-out and archive of past shutdowns, with deferred items
  • Baselines that show what moved against the plan
  • Reports and the tables behind the charts export to Excel
  • Approvals and sign-offs recorded against the signed-in user

Agenda

What should a shutdown review meeting cover?

Hold three reviews: a hot debrief within days of restart, a formal review once the final cost and schedule data exist, and a post-startup review when early-life defects have shown; each has a different agenda.

Three review meetings and their agendas
MeetingWhenWhoAgenda
Hot debriefWithin a few days of restart, while memory is freshShutdown manager, area leads, operations, key contractorsWhat went well; what went wrong; top delays; safety events; immediate fixes. Capture lessons in the template; no solutions debate
Formal reviewWithin weeks of restart, after final cost and schedule data existShutdown manager, planner, cost controller, safety, reliability, contractsPlanned versus actual schedule, cost and scope; scope growth; contractor performance; materials; permit and safety record; validate each lesson and assign actions
Post-startup reviewAfter the plant has run long enough for early-life defects to showReliability engineer, operations, shutdown managerDefects and repeat failures after restart; work that should have been in scope; update asset history and the next stop scope

The timings are a working convention: no public standard fixes them. Choose intervals that fit your restart and data cycle. For the measures to review see shutdown KPIs.

Template

What does a lessons learned entry look like?

A good lessons learned entry has a title, the job, the facts, the cause, the effect, a recommendation and an action with an owner and a date, so the next planner can act on it without asking.

More free tools, including the 40-step checklist as a workbook, are in the shutdown planning templates. A worked review ending in actions: shutdown case study. A free Excel version is available: Lessons learned register (.xlsx).

Lessons learned template with an invented example
FieldWhat to writeExample (invented)
TitleShort, searchable nameSeal chamber damaged on removal
Job and areaWork package and equipmentWP-014, feed pump A, unit 2
What happenedFacts only, in orderSeal chamber scored when the old seal was pulled; spare chamber not staged; job delayed one shift
CauseRoot cause, not blameJob plan lacked a check of chamber condition; no spare listed
EffectTime, cost, safety, qualityOne shift lost on a critical-path job
RecommendationWhat to do next timeAdd chamber inspection step and a spare chamber to the package
Action, owner, dateWho changes what by whenPlanner updates job plan by next planning round
StatusOpen, validated, appliedValidated; applied after next review

The example is invented to show the format. Keep the entry short, and keep the cause about the system rather than a person. A lesson with no action and no owner is only a note.

Inputs

Where do shutdown lessons come from?

The best lessons come from records you already keep: the daily meeting log, the emergent work register, the punch list, safety and near-miss records, planned-versus-actual data and defects after restart. 3

To measure the return from the actions, see shutdown program ROI. Regulated plants should also see pharmaceutical plant shutdowns. If you are moving to S/4HANA, keep the history: SAP S4HANA maintenance data migration.

Where shutdown lessons come from
SourceWhat it gives you
Daily meeting minutes and action logDelays, recurring problems and decisions as they happened
Emergent work and findings logWhat the scope missed, and by how much; input to the next scope
Punch list and quality recordsWhere completion control was weak
Permit, safety and near-miss recordsControls that failed or worked
Planned versus actual schedule, hours and costEstimating accuracy; where the estimates were weak
Contractor and operations feedbackAccess, materials, coordination and handover issues
Post-startup defects and repeat failuresWork that should have been in the stop

Ask contractors and operations for feedback too. Shift handover problems are a common source; HSE describes handover as preparation, an exchange and a cross-check. 3 Feed validated lessons into the next shutdown plan, the scope and the risk register.

Rules

Do rules require shutdown lessons learned?

No rule requires a shutdown lessons learned report as such, but US process safety rules require documented responses to audit findings and incident investigations, and the DOE standard shows what a working program contains. 1,2

For the audit side, see shutdown audit checklists and findings.

Rules that touch lessons learned
TopicRule or guidanceWhat it saysSource
Lessons learned programDOE-STD-7501-99Defines a lesson learned and describes a program with a development process (identify, document, validate, disseminate) and a utilization process; applies to DOE and contractor organizationsDOE lessons learned standard
Audit findingsOSHA 1910.119(o)(4), US covered processesThe employer promptly determines and documents an appropriate response to each audit finding and documents that deficiencies are correctedOSHA 1910.119
Incident investigationOSHA 1910.119(m), US covered processesThe employer investigates each incident that resulted in, or could reasonably have resulted in, a catastrophic release, begins within 48 hours, and sets up a system to address and resolve the findings and document how each was resolvedOSHA 1910.119

Visuals

Save the review charts

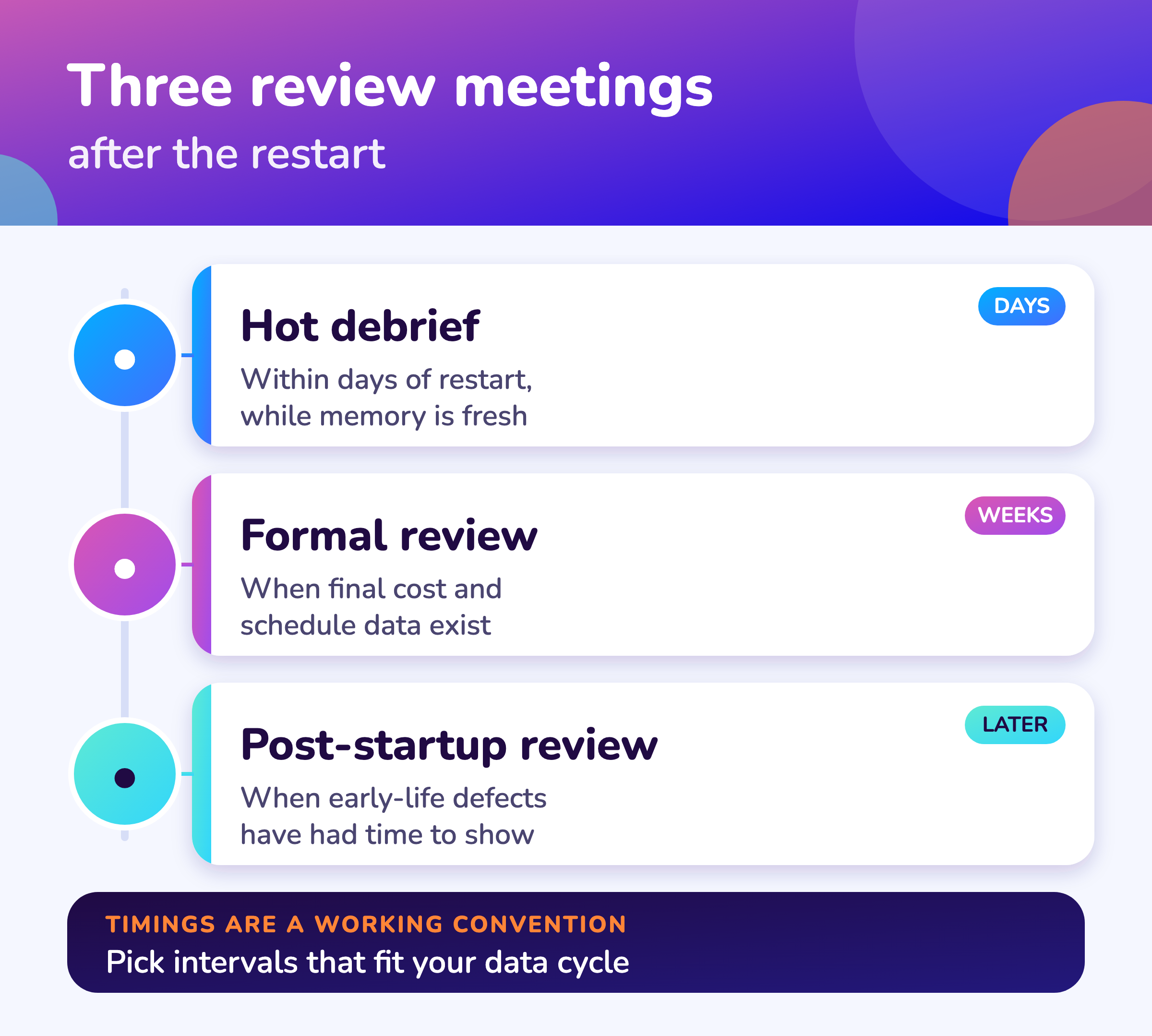

Two charts to share after the stop. Click either for the full-size image.

FAQ

Frequently asked questions

What is a shutdown lessons learned review?

A structured review after the stop that captures what worked and what did not, validates each lesson and turns it into an action. 1

When should the review happen?

In three steps: a hot debrief within days of restart, a formal review once final cost and schedule data exist, and a post-startup review after early-life defects have had time to show. The timings are a working convention.

Who should attend?

The shutdown manager, planner, area leads, operations, safety, contracts, cost control and reliability, and key contractors for the hot debrief.

What should a lessons learned entry contain?

A title, the job, what happened, the cause, the effect, a recommendation, and an action with an owner and a date.

How do you avoid blame?

Write the cause about the system, and keep the way of raising a lesson simple. The DOE standard says there should be no stigma or blame for the person who raises one. 1

Where do the lessons go afterward?

Into the next plan: job plans, checklists, estimates, the risk register and the scope of the next stop. See how to plan a plant shutdown and the 40-step checklist.

What is the difference between lessons learned and KPIs?

KPIs show how the stop performed; lessons explain why and what to change. Use both. See shutdown KPIs.

Is there a standard for lessons learned?

The US Department of Energy has a lessons learned program standard that many organizations use as a model. 1 No shutdown-specific standard was found.
