Risk assessment

Shutdown Risk Assessment: Method, Matrix and Register

Short answer

Shutdown risk assessment identifies what could harm people or delay the restart, scores each risk by likelihood and severity, assigns controls and owners, and records them in a register that is reviewed as the stop changes. This guide gives the five steps, a 5 by 5 matrix with a scoring tool and a sample register.

The matrix scale and sample register are working templates; set your own limits with your safety team.

How MaintWiz helps: Risks that are tracked with owners are easier to close. The MaintWiz shutdown module checks seven readiness gates before a package starts and records waivers with a typed reason, name and date. See the module · Get the readiness checklist

By · Published · Last reviewed

What MaintWiz adds:Seven readiness gatesSigned waivers with name and dateKeyboard operationLook-ahead by gate

Method

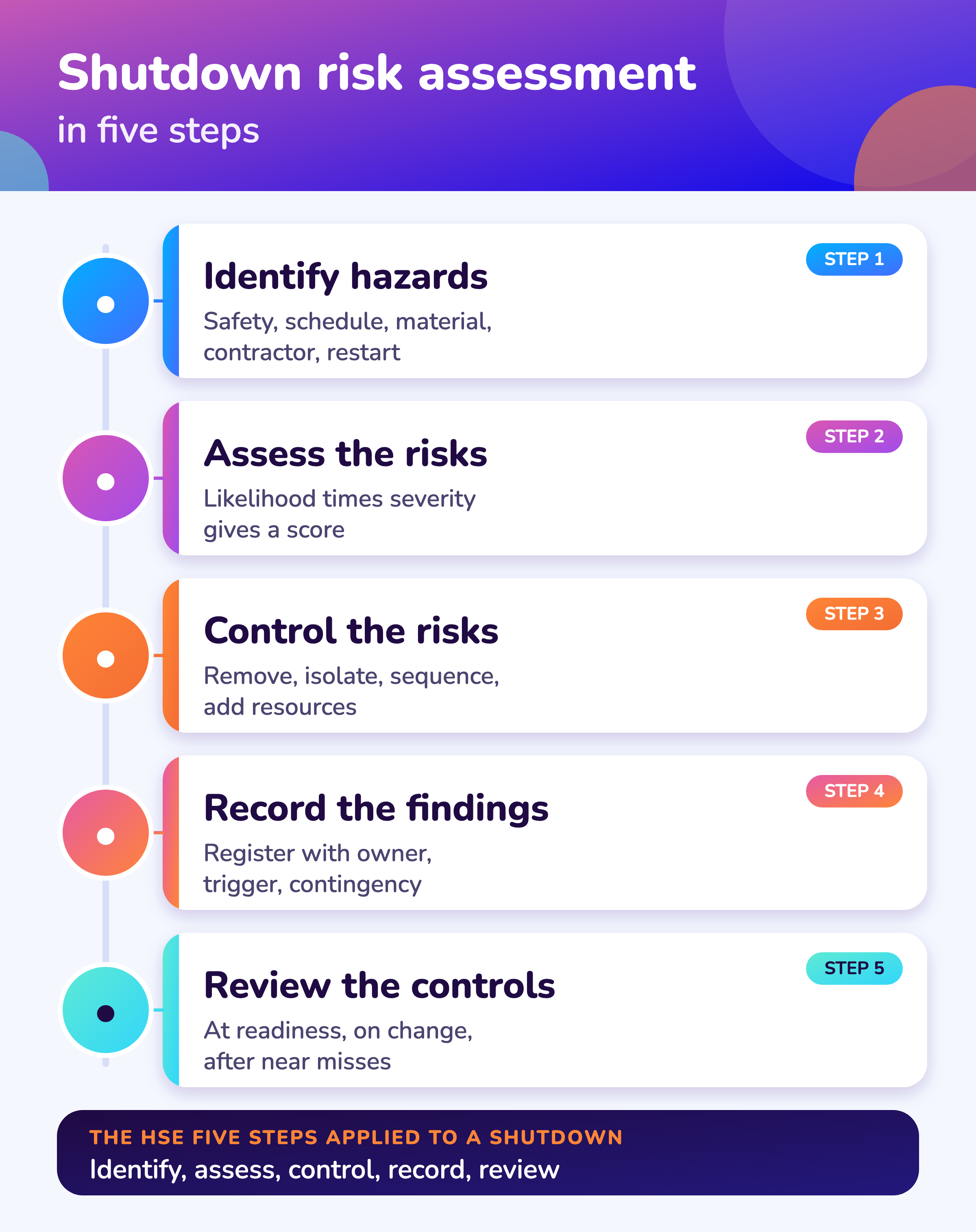

How do you assess risk in shutdown planning?

Assess shutdown risk in five steps: identify hazards, assess how likely and how serious each is, control it, record the findings in a register and review the controls as the stop changes. 1

Risk and hazard analysis terms are defined in the shutdown turnaround glossary.

The UK Health and Safety Executive describes risk assessment in five steps and says employers with five or more staff must record significant findings. 1 The same steps work for a shutdown, with schedule, material and contractor risks added beside safety hazards. The risk register is step 17 of the 40-step checklist.

HSE five steps of risk assessment applied to a shutdown
StepHSE wordingIn a shutdown, this means
1Identify hazardsList hazards per work package: energy sources, confined spaces, lifting, hot work, chemicals, simultaneous work, and schedule, material and contractor risks
2Assess the risksJudge how likely harm or delay is and how serious it would be, and who or what is affected
3Control the risksRemove the hazard if possible; otherwise reduce the risk with isolation, procedures, sequencing, extra resources or contingency
4Record your findingsKeep a risk register with the hazard, score, controls, owner and trigger
5Review the controlsReview at the readiness meeting, when scope changes, after incidents or near misses, and daily on the critical items

The right-hand column is our application of the HSE steps to shutdowns, not HSE wording. HSE also says you can assess the risks yourself or appoint a competent person, and that employees usually have useful ideas.1

Risk matrix

What does a 5 by 5 shutdown risk matrix look like?

A 5 by 5 risk matrix scores each risk from 1 to 25 by multiplying likelihood (1 to 5) by severity (1 to 5), then bands the score as low, medium, high or critical so the register can be ranked. A severity 5 event is rated High at likelihood 2 and Critical at likelihood 3 or more, so a catastrophic outcome is never hidden by a low score.

A 5 by 5 risk matrix: score = likelihood x severity
Likelihood \ Severity1 Minor2 Moderate3 Serious4 Major5 Severe
5 Almost certain5: Medium10: High15: High20: Critical25: Critical
4 Likely4: Low8: Medium12: High16: High20: Critical
3 Possible3: Low6: Medium9: Medium12: High15: Critical
2 Unlikely2: Low4: Low6: Medium8: Medium10: High
1 Rare1: Low2: Low3: Low4: Low5: Medium

Try it: score a risk

Pick a likelihood and a severity. The score and the band update. Nothing is sent or stored.

Score9
BandMedium

The scale, scores and band limits (1 to 4 low, 5 to 9 medium, 10 to 16 high, 17 to 25 critical, with the severity 5 rule above) are a common working convention and a template, not a standard. Set your own limits with your safety team, and give each band a required response.

Software

Can software support shutdown risk assessment?

Software cannot judge a risk for you, but it can hold the register next to the schedule, flag float running out, and keep every waiver and sign-off with a name, a date and a reason.

About MaintWiz. MaintWiz is an industrial AI platform with IoT, SAP integration and predictive maintenance (PdM) capabilities. Its shutdown and turnaround module helps plants plan, schedule, execute and close out shutdown work.

Planned for later releases: risks ranked by the days at stake and Monte Carlo confidence of finish.

What the shutdown module covers

As described on the MaintWiz shutdown maintenance product page.

  • Risk register with score and owner
  • Readiness gates with waivers and sign-offs recorded with a reason, the name and the date
  • Critical path and float flags at a limit you set
  • Permits and isolations from ePTW on each work order, with a block on closing a package while one is open
  • Findings from the field sent to the planner as requests for added work
  • Executive view that ranks decisions by effect in days and money

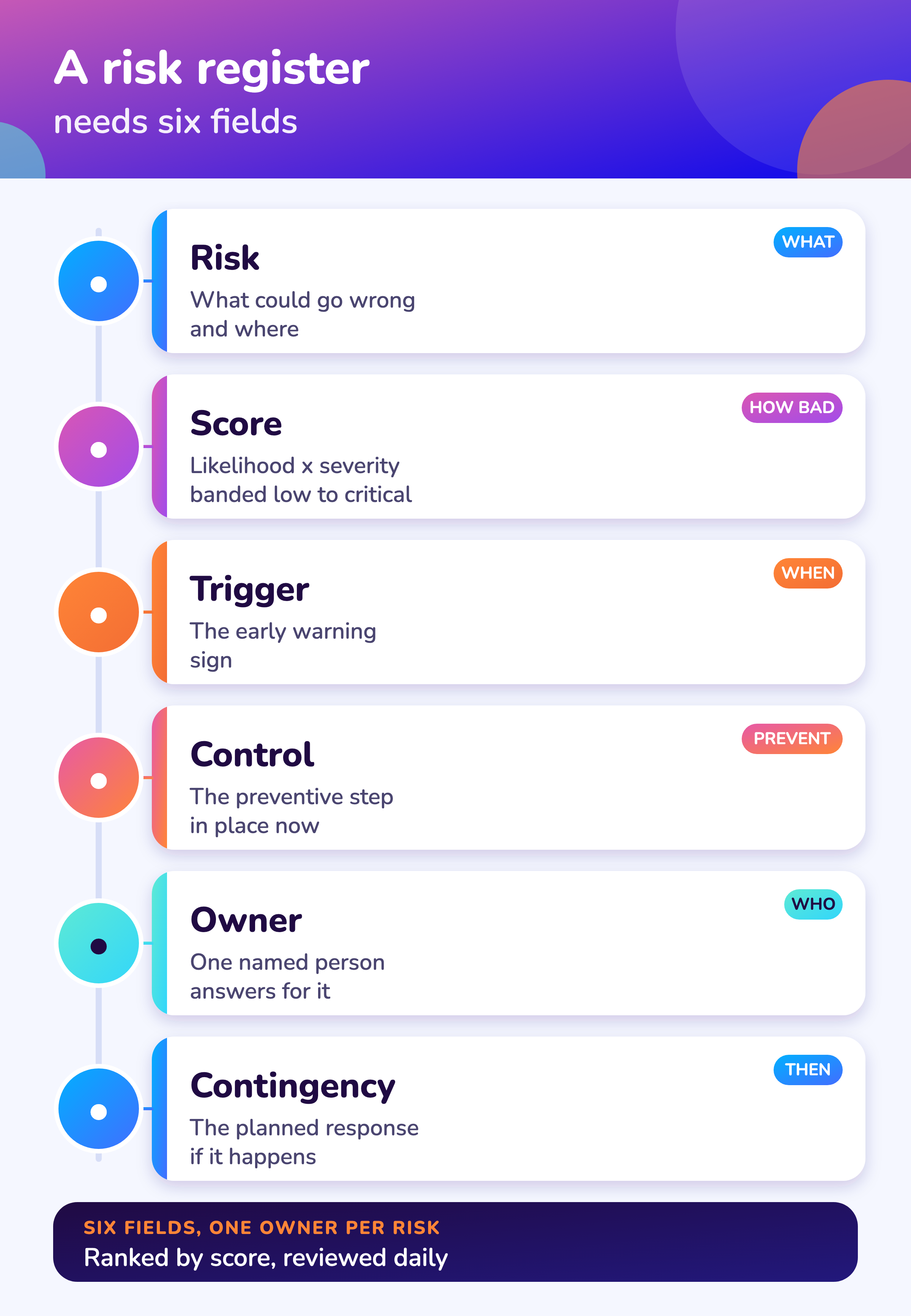

Register

What goes in a shutdown risk register?

A shutdown risk register lists each major risk with a score, a trigger, a preventive control, an owner and a contingency, so every risk has a person, a warning sign and a planned response.

Schedule risks show as lost float; check it in the Excel to Gantt tool. A free Excel version is available: Risk register with 5x5 matrix (.xlsx).

The entries below are invented examples to show the format, not a list for your plant. Rank the register by score and review the top items at the readiness meeting and every day in the daily meeting.

Illustrative shutdown risk register (invented entries)
CategoryRiskScoreTriggerPreventive controlOwnerContingency
SafetyGas release when breaking a line2 x 5 = 10: HighGas released during line breakVerified isolation and blind; gas test; permitSafety leadStop work; evacuate; review isolation
SafetyDropped load during a heavy lift2 x 5 = 10: HighLift plan not followedLift plan; exclusion zone; certified riggerArea leadSuspend lift; re-plan
ScheduleLong-lead part arrives after the start4 x 4 = 16: HighDelivery not received by day -14Receive and check before the freeze; track weeklyMaterials plannerExpedite; substitute or re-sequence
ScheduleEmergent scope on the critical path4 x 3 = 12: HighInspection finding on a critical jobReserve float and crew; approve changes in writingShutdown managerRecovery plan: extra shifts, parallel work
ContractorContractor crew short or late3 x 3 = 9: MediumHeadcount below plan on day 1Confirm capacity before the window; induct earlyContracts leadBackup contractor; reassign in-house
QualityRe-work after a failed test3 x 3 = 9: MediumFailed pressure or leak testHold points; qualified inspectorsInspection leadRe-test slot reserved in the schedule
RestartRestart delayed by open punch items3 x 4 = 12: HighCritical punch items open at day -2Live punch list; classify by startup effectOperations leadDelay restart; staged startup
EnvironmentalSpill during draining or cleaning2 x 3 = 6: MediumDrain or hose failureContainment; trained crew; spill kitSafety leadContain; notify; clean-up plan

Risk links to other plans: scope growth is covered in scope management, safety hazards in the shutdown safety plan, and permits in the permit to work guide.

Rules

Which shutdown risk work do US and UK rules address?

No rule prescribes a 5 by 5 matrix, but the HSE five steps, OSHA process hazard analysis and change rules and HSE isolation and permit guidance all feed the shutdown risk register. 1,2

The shutdown audit tests whether these controls are in place.

Risk work that US and UK rules or guidance address
ActivityRule or guidanceWhat it saysSource
The risk assessment stepsHSE five stepsIdentify hazards, assess the risks, control the risks, record the findings, review the controlsHSE five steps
Process hazard analysis (US covered processes)OSHA 1910.119(e)A process hazard analysis must identify, evaluate and control the hazards of the process; a team with engineering and process expertise performs it; it is updated and revalidated at least every five yearsOSHA 1910.119
ChangesOSHA 1910.119(l)Written procedures manage changes to the process, except replacements in kindOSHA 1910.119
Isolation riskHSE HSG253Plan intrusive maintenance for shutdown periods to keep isolation needs downHSE HSG253
PermitsHSE HSG250Permit-to-work guidance for the petroleum, chemical and allied industries, including risk assessmentHSE HSG250

Visuals

Save the risk charts

Two charts to share with the team. Click either for the full-size image.

FAQ

Frequently asked questions

What is a shutdown risk assessment?

A structured look at what could harm people or delay the stop, how likely and how serious each risk is, and how it will be controlled. The HSE describes five steps: identify hazards, assess, control, record and review. 1

What is a risk matrix?

A grid that scores each risk by likelihood and severity. A 5 by 5 matrix gives scores from 1 to 25. The scale and the band limits are a convention that each company sets for itself.

What should a shutdown risk register contain?

For each major risk: a description, a score, the trigger that warns you, the preventive control, an owner and a contingency.

When should the risk assessment be done?

Start in planning and have a register ready before the readiness review; it is step 17 of the 40-step checklist. Review it whenever the scope changes.

Who should be involved?

The shutdown manager, planner, operations, safety and the area leads, with contractors for their scope. HSE notes that employees usually have useful ideas. 1 For US covered processes a process hazard analysis team needs engineering and process expertise. 2

Does OSHA require a risk assessment for a shutdown?

OSHA 1910.119 requires a process hazard analysis for covered processes and written change procedures, not a shutdown-specific assessment. 2

How do you deal with a critical risk?

Remove it if you can; if not, reduce it with controls before work starts, assign an owner and set a trigger and a contingency. Escalate a critical risk to the shutdown manager.

How is schedule risk different from safety risk?

Safety risks threaten people; schedule risks threaten the restart date. Both go in one register. Schedule risk shows up as lost float on the critical path. 5 See shutdown scheduling.
