Schedule delays

Shutdown Schedule Delays: Causes, Indicators and Recovery

Short answer

Shutdown schedules slip for a short list of reasons: scope added after the freeze, double-booked crews, late materials, permit and isolation waits, logic and float errors, and unreliable progress data. Each has an early indicator and a standard response, and only a delay beyond a job's float moves the finish date.

There is no published data on how much shutdowns overrun, so this page gives causes and methods, not percentages.

How MaintWiz helps: Delays are cheaper to fix when you see them on the critical path early. The MaintWiz shutdown module puts the whole shutdown on a Gantt chart with the critical path, float and baselines, so you can see what moves the finish date. See the module · Get the Gantt template

By · Published · Last reviewed

What MaintWiz adds:Gantt with critical path and floatBaselines show what movedFloat flag at your limitOne plan from portfolio to task

Causes

What causes shutdown schedule delays?

Shutdown schedules slip mainly because of scope added late, resource conflicts, late materials, permit and isolation waits, logic and float errors, unreliable progress data and shift handover failures, each of which has a leading indicator and a standard response. 1,2,4

Late parts are a leading cause; see shutdown spare parts planning. On cost overruns, see why shutdowns go over budget. For SAP requisitions and late parts see SAP MM shutdown materials.

Delay causes with indicator, prevention and recovery
CauseHow it shows upLeading indicatorPreventionRecoveryBasis
Scope added after the freezeWork list grows; critical-path jobs extendScope growth, open change requestsFreeze the scope; plan contingency; decision rule for late workDefer what can wait; approve only with a stated schedule effectNERC treats discovery work as outside the original scope NERC GADS
Crews or equipment double-bookedA job waits for a crew that is still on another jobResource peaks above availabilityResource-load the schedule and level itAdd shifts or crews on critical jobs onlyGAO resource-loaded schedule GAO schedule guide; HSE competing demands HSE HSG253
Materials not at the work faceJobs start late or stop for partsKits complete versus jobs dueOrder long-lead items first; kit before the stopExpedite for critical jobs; re-sequence othersWorking analysis
Permit and isolation waitsCrews standing by for a permit or an isolationPermits waiting; issuer queueRoster issuers for peak days; limit active permitsAdd issuer resource; clear the oldest waits firstHSE on permit supervision at shutdown peaks HSE HSG250
Logic and float errorsFloat used up unnoticed; date constraints hide the real critical pathFloat consumed on near-critical jobsReview the logic; treat float as shared, not contingencyRecalculate daily; escalate near-critical jobsGAO on float and constraints GAO schedule guide
Unreliable progress dataPercent complete looks fine until the last dayDisagreement between reported and observed progressMeasure completed steps against actual datesRe-measure the critical-path jobs on siteGAO: percent complete is subjective GAO schedule guide
Shift handover failuresWork repeated or restarted after a shift changeHandover log gapsFace-to-face, two-way handover with a logRestate status at the next meetingHSE on shift handover HSE shift handover

The order is a working view, not a ranked statistic; there is no published data on cause frequency. Rows without a public source are labeled working analysis.

Calculator

When does a late job actually delay the finish?

A late job delays the finish only by the amount its slip exceeds its total float; GAO defines total float as the time an activity can slip before its delay affects the end date. 1

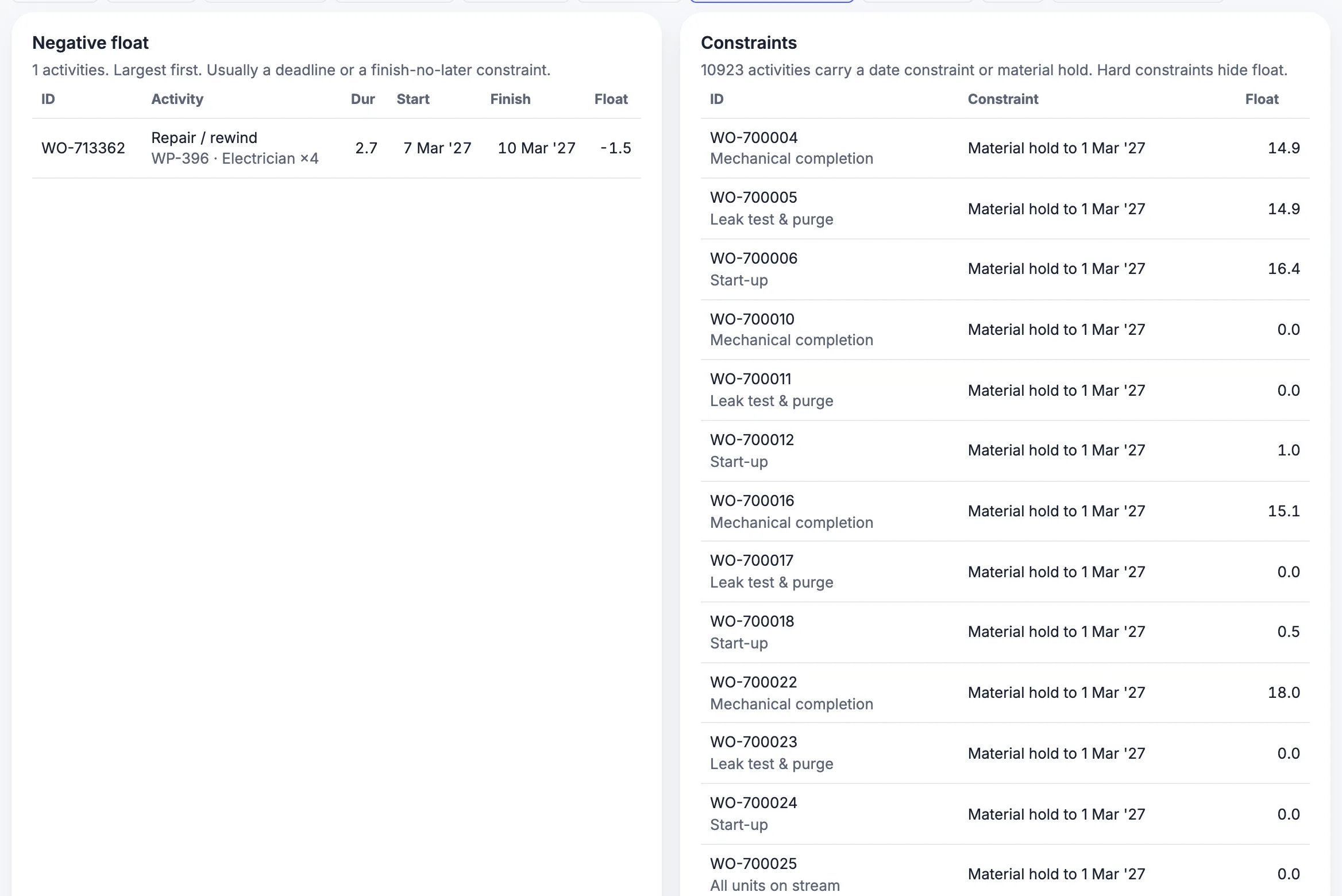

MaintWiz: negative float list and constraints during execution
Negative float and constraints. Where float has run out.

See also the other shutdown calculator tools. The Excel to Gantt tool shows the float of every task in a list.

Try it: how far does one late job move the finish?

Enter an activity's total float and how many days it slips. The result follows the schedule logic that GAO describes. Nothing is sent or stored; the sums run in your browser.

Delay to the finish date, days
Float left, days
Status

GAO also says float should not be treated as schedule contingency, because it is shared along a sequence of activities, and that management should closely monitor critical and near-critical activities. 1 The critical path method is explained in shutdown scheduling.

Software

Can software help prevent delays?

Software can show float, resource peaks, permit queues and material status against the schedule in one view, so the warnings above are visible before a job is late.

Float flags are listed in the shutdown module data sheet.

About MaintWiz. MaintWiz is an industrial AI platform with IoT, SAP integration and predictive maintenance (PdM) capabilities. Its shutdown and turnaround module helps plants plan, schedule, execute and close out shutdown work.

Also: product data sheet.

What the shutdown module covers

As described on the MaintWiz shutdown maintenance product page.

  • Shutdown calendar and critical-path scheduling, with work order sequencing and dependencies
  • Asset prioritization, so the most critical equipment is scoped first
  • Resource planning for people, spares, heavy equipment such as cranes, and outsourced vendors
  • Electronic permits to work, risk management and contingency plans
  • Real-time progress monitoring: schedule adherence, cost variance, quality metrics and risk factors
  • Step-by-step checklists, pre-restart testing protocols and post-shutdown analysis

Indicators

Which indicators warn that a shutdown is slipping?

The earliest warnings are float used up on near-critical jobs, critical-path jobs behind plan, a schedule performance index below 1.0, permits waiting for issue and kits incomplete for jobs due soon.

For what a delay costs, see planned vs unplanned shutdown cost.

Track a few of these every day and show them at the morning meeting. The index formulas are in shutdown KPIs and the daily routine in shutdown progress tracking. There is no published benchmark for any of them, so compare against your own previous shutdowns.

Recovery

How do you recover a shutdown that is falling behind?

Recover with a plan, not with float: re-sequence work, add shifts or crews to critical-path jobs only, defer work that can wait through the decision rule, and record why each change was made. GAO says float is shared and should not be used as contingency. 1

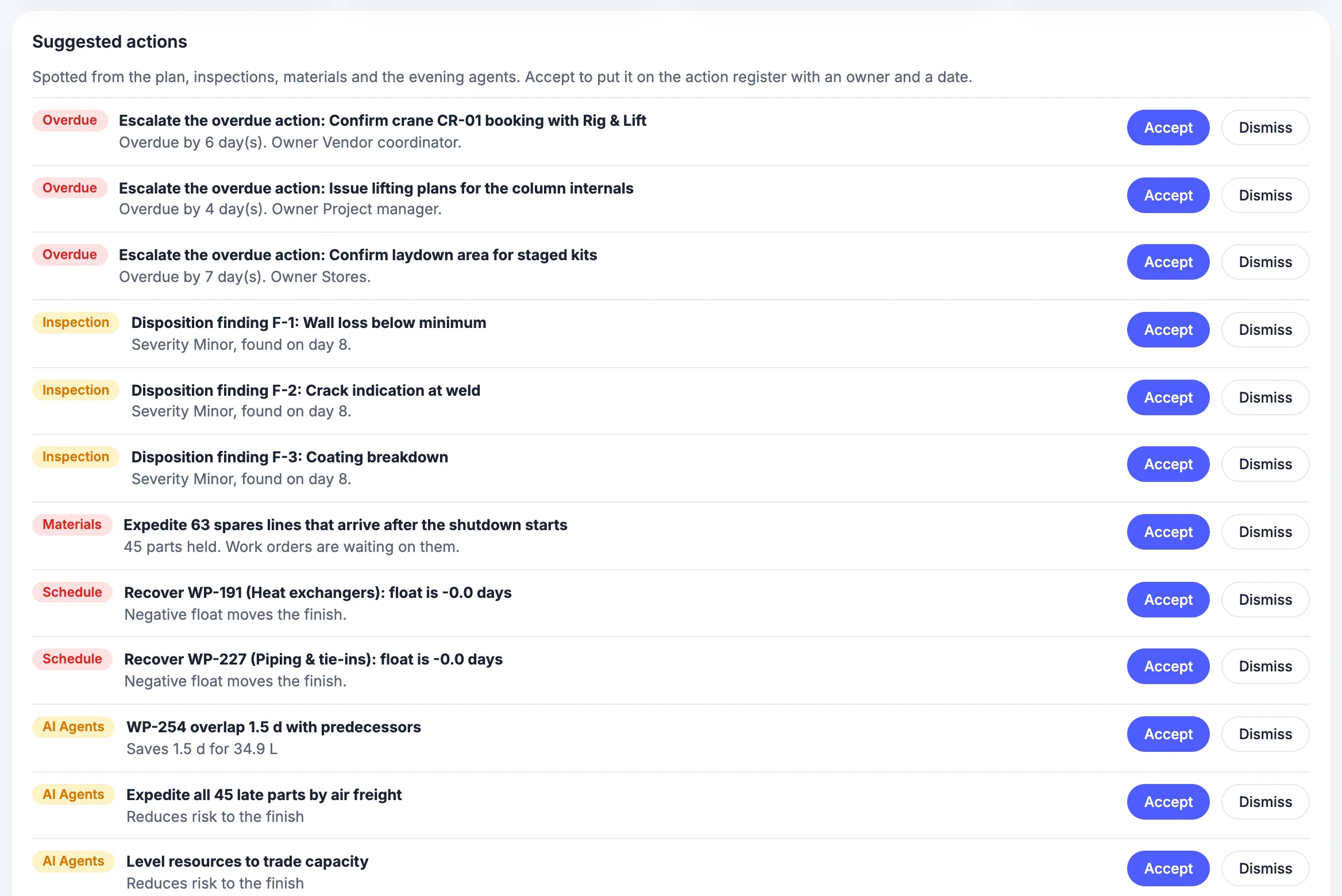

MaintWiz: list of suggested actions generated from the live shutdown numbers
Suggested actions. Rule-based suggested actions from live numbers.

The arithmetic of float is worked in critical path vs critical chain. See critical path vs critical chain for the float arithmetic. For treatment plants and isolating one unit at a time, see water and wastewater plant outages. Spot a slip early with the schedule index and the three-day look-ahead in the shutdown S-curve and percent complete guide.

The decision rule for work found late is in shutdown execution, and scope control is in shutdown scope management. Recovery options are working guidance and each carries a cost; check the effect with your cost forecast in shutdown budget planning.

Evidence

How often do shutdown schedules overrun?

There is no published figure for how often shutdown schedules overrun, or by how much,, so this page gives none.

Refueling outages show the spread: US averages and longest outages are in nuclear refueling outage planning. A worked example of a late finish: shutdown case study planned vs actual duration.

Power-plant reporting shows how one sector treats overruns: NERC says extra time on a task that was in the original scope is a planned extension, while extra time to repair damage found during an inspection is coded as a forced outage. 2 Earlier versions of this page said the data was sobering without citing any; that was removed. Cost overruns are covered in why shutdowns go over budget.

Visuals

Save the delay charts

Two charts for the daily meeting. Click either for the full-size image.

FAQ

Frequently asked questions

What are the main causes of shutdown delays?

Scope added after the freeze, double-booked crews, late materials, permit and isolation waits, logic and float errors, unreliable progress data and shift handover failures. 1,2,4

When does a late job delay the whole shutdown?

When its slip exceeds its total float. GAO defines total float as the time an activity can slip before its delay affects the end date. 1

Can float be used as contingency?

No. GAO says float should not be treated as schedule contingency because it is shared along a sequence of activities. 1

How do you recover a delayed shutdown?

Re-sequence work, add shifts or crews to critical-path jobs only, defer work that can wait and record each change. Recovery options are working guidance and each has a cost.

Why is percent complete unreliable?

GAO says it is subjective, and more so for long activities. Measure completed steps against actual dates instead. 1

How do permit delays cause schedule delays?

HSE notes that permit supervision thins when many permits sit with one person at shutdown peaks, so jobs wait. It advises limiting active permits or adding resource. 4

What does a shift handover failure cost?

There is no published cost figure. HSE says many accidents followed communication failures at handover and that most involved planned maintenance work. 5

How much do shutdown schedules overrun?

There is no published figure. Track your own duration variance with the formula in the KPI guide.

Put your shutdown schedule in one plan

Book a demo and bring your shutdown schedule. We will show how the module handles the critical path, float and baselines.

Book a demo
