Turnaround Software RFP Template: Sections and Questions

Short answer

A turnaround software RFP has eleven sections and about fourteen questions that every vendor answers the same way, followed by a live demo on your own data and a weighted score. The free Excel template holds the sections, questions, a response grid and a timeline. MaintWiz answers an RFP with a demo on your task list.

How MaintWiz helps: An RFP works when every vendor answers the same questions on your data. The MaintWiz shutdown module moves the plan from spreadsheets into one system with a critical path, readiness gates, permits and spares status. See the module · Get the RFP template

By · Published · Last reviewed

What MaintWiz adds:Critical path and floatReadiness gatesPermits and isolationsSpares status with SAP

Definition

What is a turnaround software RFP?

A turnaround software RFP is a written request that gives vendors the same description of your shutdowns, users, data and systems, asks the same questions and sets the same scoring rules, so that proposals can be compared fairly. In this guide STO means shutdown, turnaround and outage.

A good RFP is short on adjectives and long on facts. It states how many shutdowns you run, how many tasks each has, who will use the tool and what must connect to it. It then asks vendors to show, not tell. The template below gives you the sections and fourteen questions; edit them to fit your plant.

Download the free RFP template (Excel) with sections, questions, a response grid and a timeline. Pair it with the turnaround software checklist for the features to require.

Sections

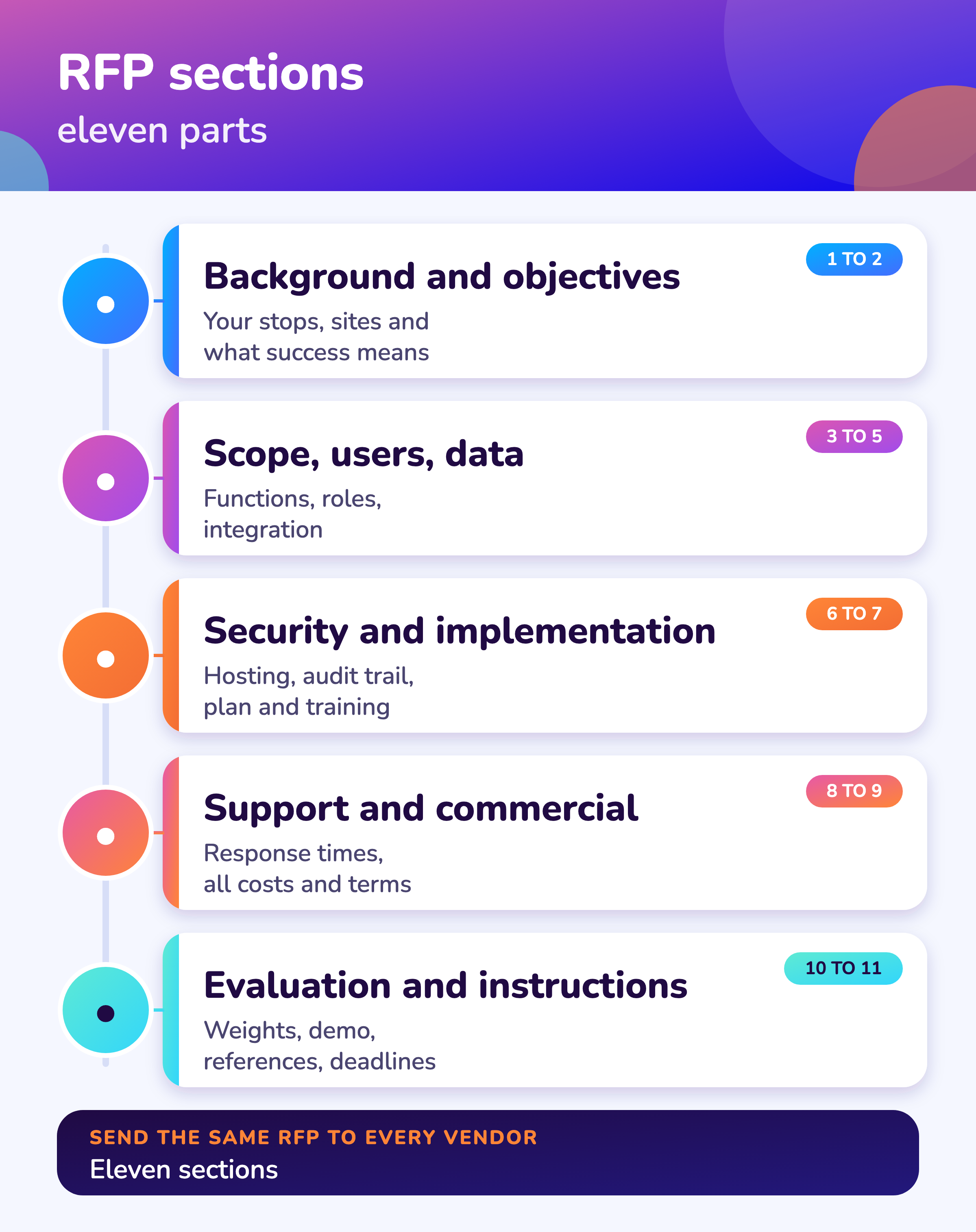

What sections should a turnaround software RFP have?

A turnaround software RFP should have eleven sections: background, objectives, scope of the system, users and roles, data and integration, security and hosting, implementation, support, commercial terms, evaluation and response instructions.

RFP sections and what to write
SectionWhat to write
1 BackgroundYour company, sites, shutdowns a year, tasks per stop, contractors, current tools
2 ObjectivesWhat the software must achieve and how you will measure it
3 Scope of the systemPlan, prepare, execute, control and close functions required
4 Users and rolesNumber and type of users, contractors, executives, mobile needs
5 Data and integrationData to load, the ERP or CMMS to connect, permit system, sign-in
6 Security and hostingHosting location, access control, audit trail, backup, data ownership
7 ImplementationPlan, timeline, who does what, training, a pilot stop
8 SupportHours, response times, escalation, updates
9 CommercialPricing model, all one-time and yearly costs, term and exit terms; see software cost
10 EvaluationCriteria, weights, a demo script and reference checks
11 InstructionsResponse format, contact, deadlines, confidentiality

MaintWiz

How does MaintWiz respond to an RFP?

MaintWiz answers an RFP with a live demo on your own task list, written answers on integration and implementation, and customer references; AI agents support shutdown planning.

Send us your RFP or your requirement list and we will run the demo scenarios on your data. Plant requirements shape what we build next.

About MaintWiz. MaintWiz is an industrial AI platform with IoT, SAP integration and predictive maintenance (PdM) capabilities. Its shutdown and turnaround module helps plants plan, schedule, execute and close out shutdown work.

What the shutdown module covers

As described on the MaintWiz shutdown maintenance product page.

  • Gantt chart with critical path, float and baselines
  • Seven readiness gates with signed waivers
  • Permits and isolations shown on each work order
  • Spares status with the SAP request or order behind each short part
  • Findings from technicians sent straight to the planner
  • Earned value, cost and schedule indices

Questions

What questions should a turnaround software RFP ask?

A turnaround software RFP should ask each vendor to show how the system handles scope and baselines, the critical path, readiness blocks, field entry, cost control, close-out, integration, security, AI features, implementation, full costs and references.

Questions to put to every vendor
AreaQuestion
ScopeShow how the system holds a scope list, work packages and an approved baseline. How is late scope added and approved?
ScheduleDoes it calculate the critical path and float on the whole network? Can we import from Excel or a scheduler?
ReadinessCan a job be blocked when a permit, isolation or part is open? How are waivers recorded?
ExecutionHow do technicians enter progress, readings, photos and findings, including with no signal?
ControlWhat cost and schedule measures are produced? How is forecast to finish calculated?
CloseHow are deferred items and lessons kept for the next stop?
IntegrationWhich systems have you integrated with? What is standard scope and what is custom?
SecurityWhere is data hosted, who owns it and what audit trail exists?
AIWhich AI features are offered? What task does each do, how was it tested and who approves its output? See AI shutdown planning 2
ImplementationGive a dated plan, what you load, what we supply and success measures for a pilot
CommercialState all costs: licenses, implementation, integration, training, yearly fees, term and exit terms
ReferencesName customers with similar stops we may call

Scoring

How do you score turnaround software RFP responses?

Score each response 0 to 3 against the same weighted requirements, keep the demo scores separate from the written scores, and check references before the final decision, so the choice follows evidence rather than the best presentation. 1

  1. 1

    Weight the requirements

    Weight each 1 to 5 before you read any response.

    Fixed first
  2. 2

    Score the written answers

    Two people score independently, then agree.

    0 to 3
  3. 3

    Run the demo script

    Same eight scenarios, your data, every vendor.

    Live
  4. 4

    Check references

    Call customers with a similar stop.

    Evidence
  5. 5

    Compare total cost

    Use the worksheet in software cost.

    Cost
  6. 6

    Record the decision

    Scores, reasons and who decided.

    Audit

The RFP and demo scorecard has the weighted sheet and the demo script.

Contract

What contract terms matter in a turnaround software purchase?

The contract terms that matter are data ownership and export, the scope of implementation in writing, support response times, the price of changes and extra users, how upgrades are handled, security obligations and the right to leave without losing your data.

  • You own the data and can export it
  • Implementation scope and dates in writing
  • Support hours and response targets
  • Prices for extra users, sites and modules fixed
  • Upgrades included or priced
  • Security and audit trail obligations
  • Exit terms and data return

Visuals

Save the RFP template visuals

Two visuals for the procurement team. Click either for the full-size image.

FAQ

Frequently asked questions

What is a software RFP?

A request for proposal: a written request that gives vendors the same facts and questions so proposals can be compared fairly.

What should a turnaround software RFP include?

Background, objectives, scope, users, data and integration, security, implementation, support, commercial terms, evaluation and instructions.

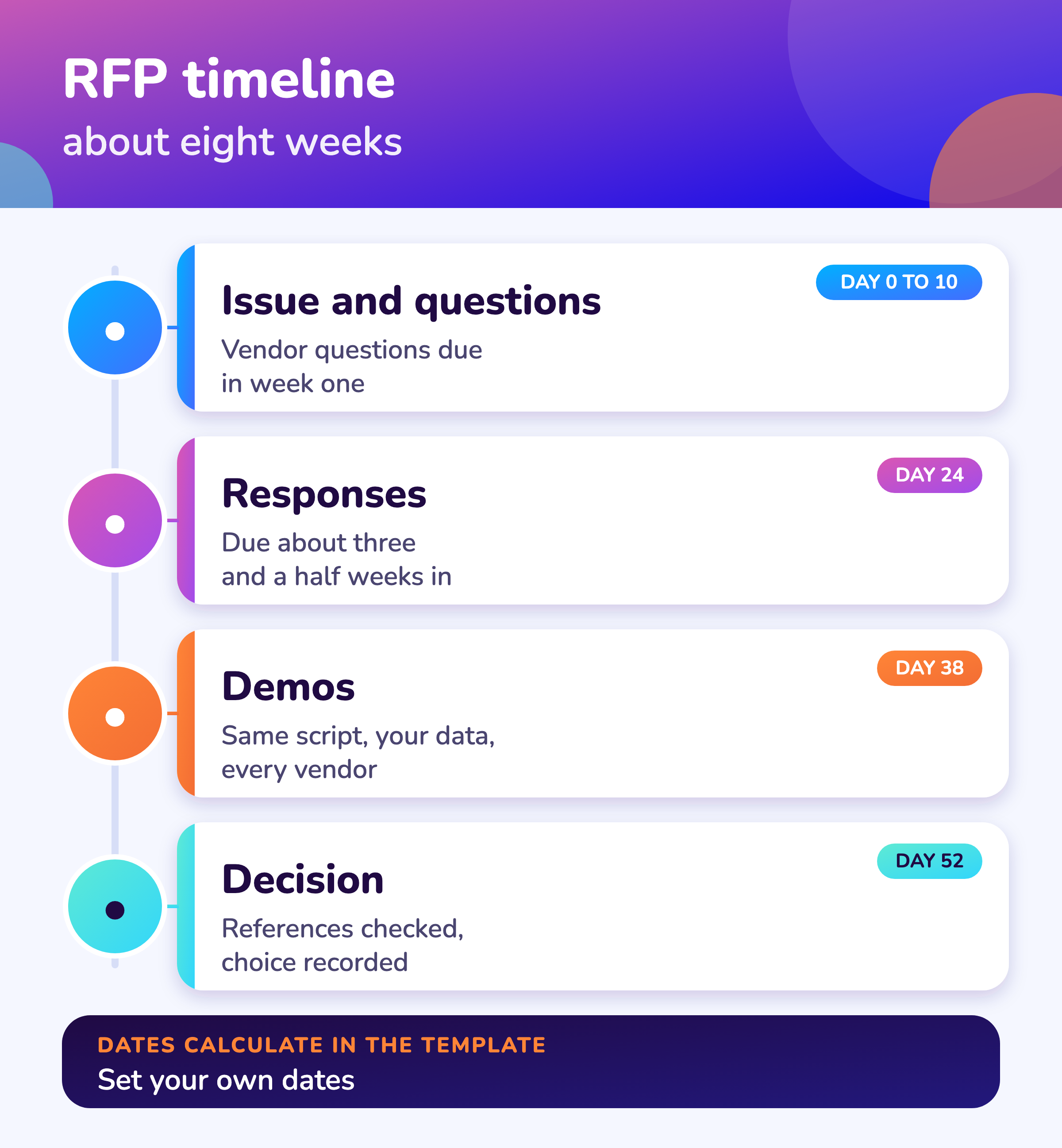

How long does an RFP process take?

About eight weeks from issue to decision is a reasonable plan: questions in week one, responses in about three and a half weeks, demos and references after.

How many vendors should we invite?

Three to five. More adds work without better information.

Should the RFP include a demo?

Yes. Ask each vendor to run the same scenarios on your sample data. The scorecard includes an eight-scenario script.

How do we score responses?

Weight requirements first, score 0 to 3 against the same criteria, score demos separately and check references.

Is there a free RFP template?

Yes. The RFP template (Excel) has the sections, fourteen questions, a response grid and a timeline.

Should we ask about AI?

Yes: ask which task each AI feature does, how it was tested and who approves its output. See AI shutdown planning.

Will MaintWiz respond to our RFP?

Yes, with a live demo on your data. AI agents are part of the module. See turnaround management software.

Sources

Sources

The RFP structure is our assessment from how software is selected. The references are the GAO schedule guide and the NIST AI Risk Management Framework, used for the schedule and AI questions.

  1. US Government Accountability Office, GAO Schedule Assessment Guide: Best Practices for Project Schedules (GAO-16-89G, December 2015)
  2. US National Institute of Standards and Technology, AI Risk Management Framework (NIST AI 100-1, 26 January 2023; Generative AI Profile NIST AI 600-1, 26 July 2024)

Move your shutdown plan out of spreadsheets

Book a demo and bring the spreadsheet you use today. We will show how the module covers the same ground.

Book a demo
