Chemical processing
Chemical Plant Shutdowns: Process Safety and Startup
For a chemical plant, the shutdown calendar is shaped by legal review cycles and by safety controls more than by a published interval: there is no published frequency or duration. OSHA's process safety standard fixes inspection, hazard analysis, change and pre-startup review cycles, and a 2018 CSB case shows what goes wrong at restart.
Sources are OSHA, UK HSE and the US Chemical Safety Board; Seveso III and other regional rules are not covered.
How MaintWiz helps: Process safety depends on isolations and permits that stay in step with the work. The MaintWiz shutdown module shows permits and isolations from ePTW on each work order and blocks closing a package while a permit or isolation is open. See the module · Get the permit register
By Jai Balachandran · Published · Last reviewed
What MaintWiz adds:Permits and isolations from ePTWShown on each work orderPackage cannot close with an open permitApprovals by signed-in user
Fact block
What do public sources say about chemical plant shutdowns?
Public sources give no vendor-neutral interval or duration for chemical plant shutdowns, but they do set legal review cycles, permit and isolation practice, and a documented lesson from a 2018 startup after a turnaround. 1,2,5
For cement kilns see cement plant shutdowns.
| Item | What public sources say | Source |
|---|---|---|
| Usual term | Plants use shutdown, turnaround or planned outage; there is no published source on word usage in chemicals | Searched; see sources |
| How often | No public, vendor-neutral interval found. Legal cycles set review dates: inspections and tests at the frequency manufacturers and good engineering practice call for; process hazard analysis updated at least every five years | OSHA 1910.119 |
| How long | No public, vendor-neutral duration found | Searched; see sources |
| US regulatory driver | OSHA process safety standard: mechanical integrity, hot work permits, contractors, management of change, pre-startup review | OSHA 1910.119 |
| UK guidance | HSE guidance for the petroleum, chemical and allied industries on permit to work (HSG250); safe isolation (HSG253); managing contractors (HSG159, aimed at the chemical industry) | HSE HSG250, HSE HSG253, HSE HSG159 |
| Public incident | Kuraray EVAL plant, Texas, 2018: 23 workers injured during reactor startup after a turnaround | CSB Kuraray report |
Review cycles

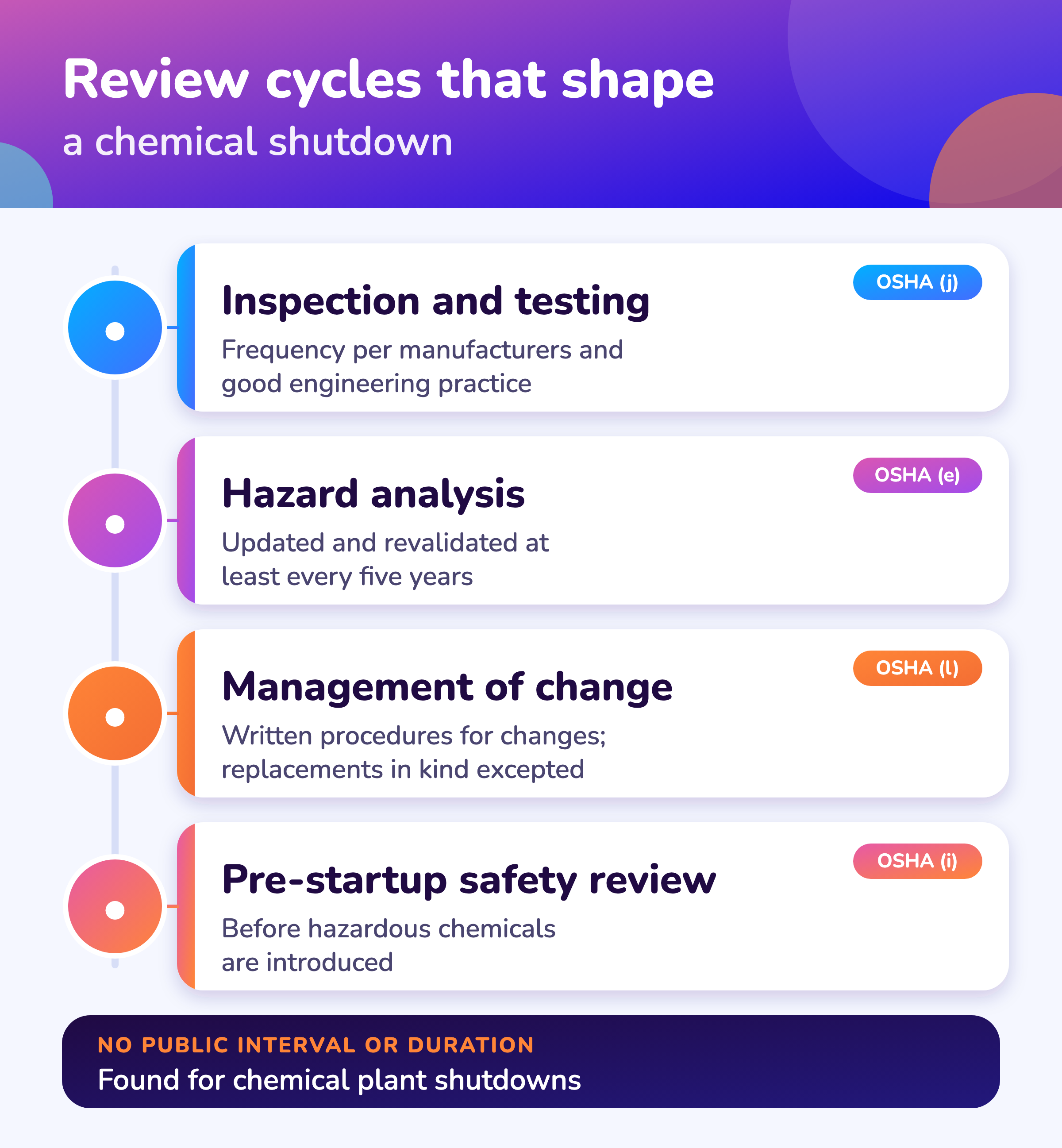

Which process safety review cycles affect chemical shutdown planning?
OSHA's process safety standard sets inspection and testing frequency, a hazard analysis update at least every five years, change management, a pre-startup review, hot work permits and contractor duties, all of which feed the shutdown scope and gates. 1
For steel plants and blast furnaces see steel plant shutdowns.
For vessels, API 510 covers in-service inspection, repair, alteration and rerating of hydrocarbon and chemical process vessels. 7
| Element | Requirement | Effect on the shutdown |
|---|---|---|
| Inspection and testing | At a frequency consistent with manufacturers' recommendations and good engineering practice, and more often if experience requires (1910.119(j)(4)(iii)) | Sets which equipment must be opened in the window |
| Process hazard analysis | Updated and revalidated at least every five years (1910.119(e)(6)) | Findings can add work to the scope |
| Management of change | Written procedures for changes; replacements in kind excepted (1910.119(l)) | Governs modifications made during the stop |
| Pre-startup safety review | Before hazardous chemicals are introduced, for new and modified facilities (1910.119(i)) | The restart gate |
| Hot work permit | For hot work on or near a covered process (1910.119(k)) | Permits for welding and cutting |
| Contractors | Duties for selecting, informing, controlling and evaluating contractors, including turnaround work (1910.119(h)) | Workforce controls |
Software
Can software help with a chemical plant shutdown?
Software can hold permits, isolation certificates, contractor records and the restart checklist together, so the evidence for each gate is on one record.



About MaintWiz. MaintWiz is an industrial AI platform with IoT, SAP integration and predictive maintenance (PdM) capabilities. Its shutdown and turnaround module helps plants plan, schedule, execute and close out shutdown work.
Also: product data sheet.

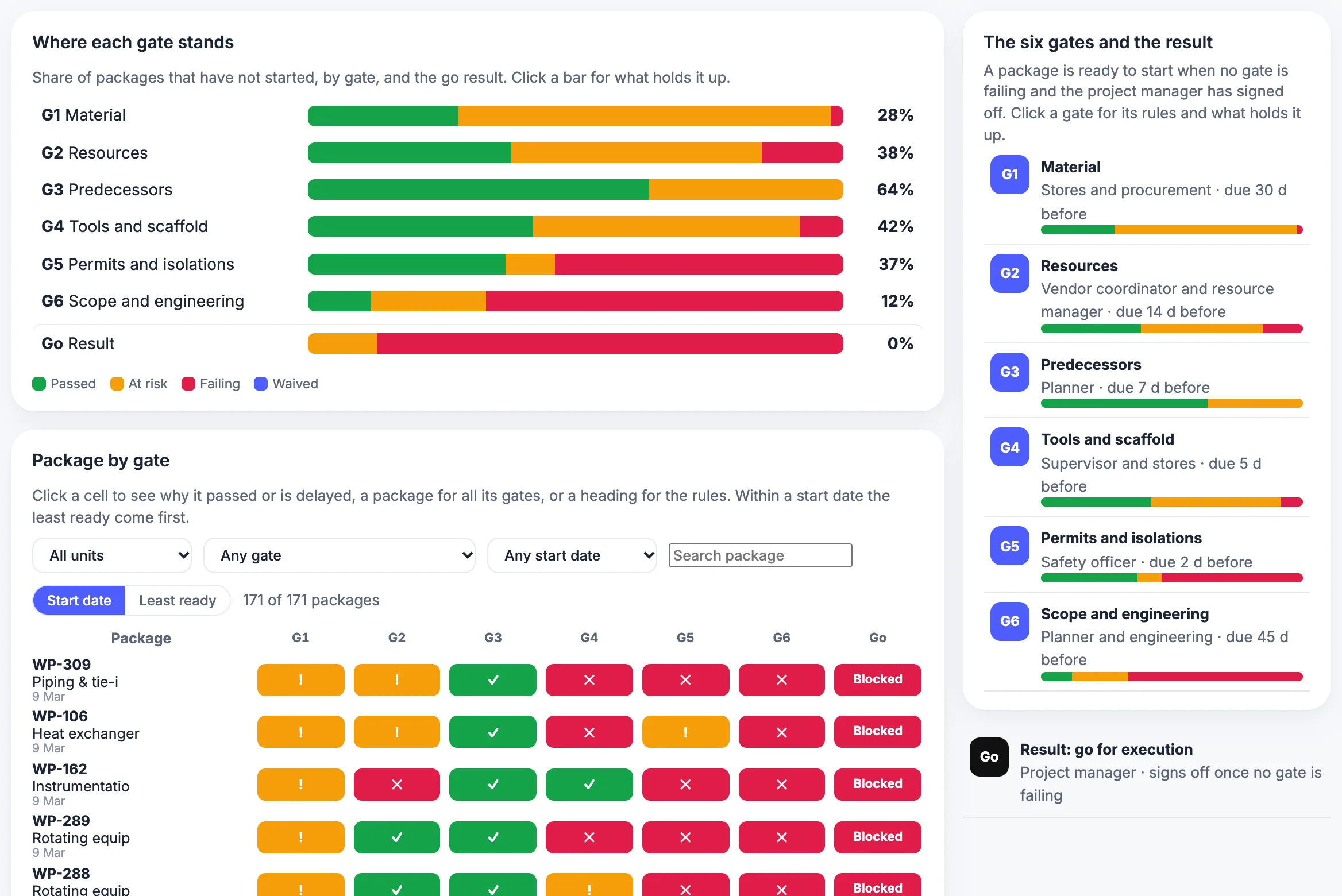

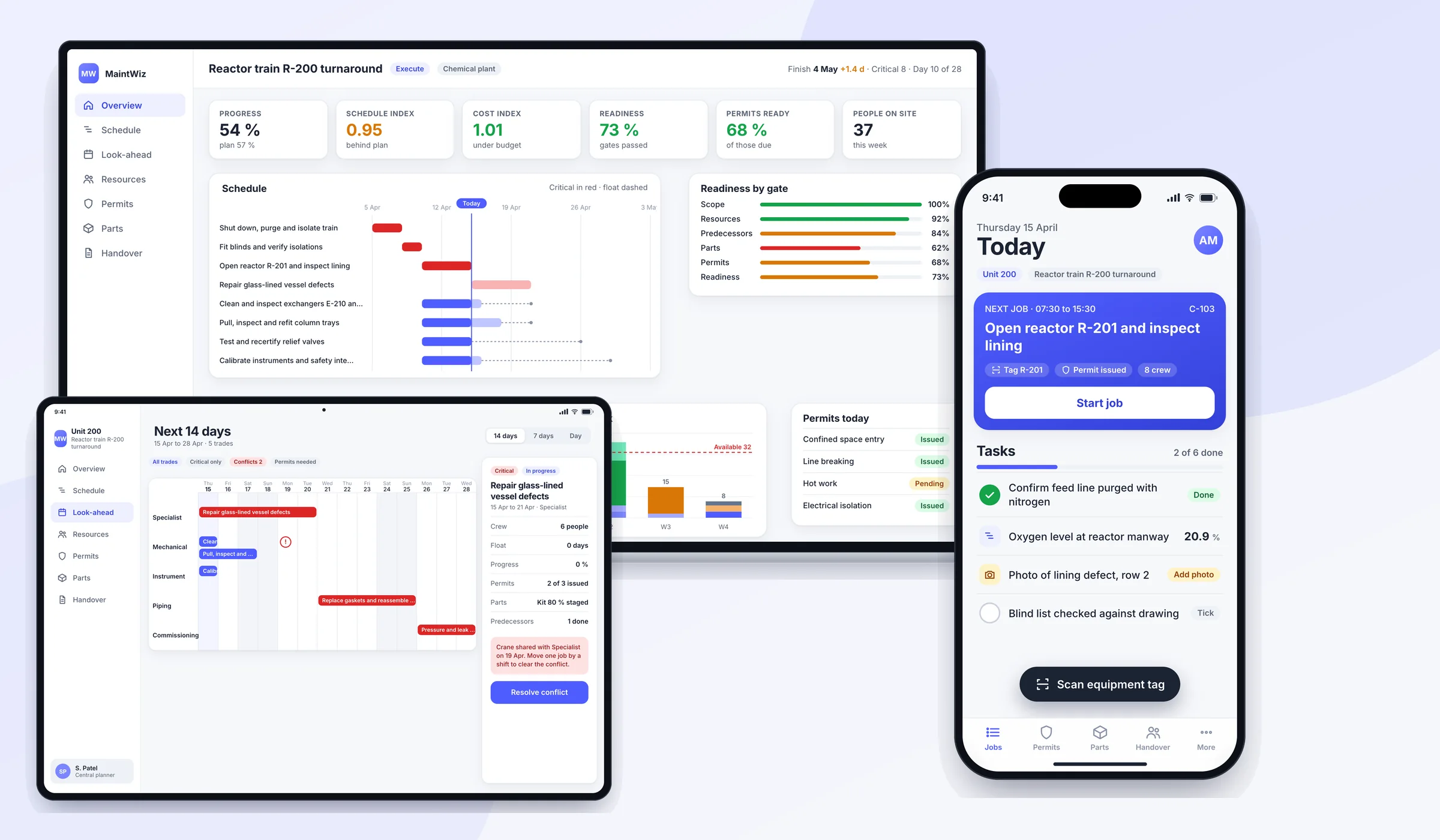

What the shutdown module covers
As described on the MaintWiz shutdown maintenance product page.
- Shutdown calendar and critical-path scheduling, with work order sequencing and dependencies
- Asset prioritization, so the most critical equipment is scoped first
- Resource planning for people, spares, heavy equipment such as cranes, and outsourced vendors
- Electronic permits to work, risk management and contingency plans
- Real-time progress monitoring: schedule adherence, cost variance, quality metrics and risk factors
- Step-by-step checklists, pre-restart testing protocols and post-shutdown analysis
Proof
What MaintWiz customers report
Figures as published in MaintWiz case studies on maintwiz.com. They come from maintenance management projects, not shutdowns.
Permits
How should permits, isolations and contractors be handled?
Use a written permit-to-work system for high-hazard maintenance, isolation certificates cross-referenced to permits, and a planned approach to contractors; HSE's guidance for the chemical and allied industries sets all three out. 2,3,4
See OSHA PSM turnaround rules for the US rules and HSG253 safe isolation for shutdowns for HSG253 and COMAH. See OSHA PSM turnaround rules for the US rules and HSG253 safe isolation for the UK.

HSG159 is aimed at small and medium chemical companies and sets out five steps: plan, choose, manage contractors on site, keep a check and review. 4 HSG250 warns that permit supervision thins out when many permits sit with one person, naming shutdowns as an example. 2 OSHA requires an entry permit before confined space entry is authorized. 6 Detail: permit to work during shutdown and contractor management.
Startup
What does a chemical plant startup after a turnaround teach?
The CSB's Kuraray report shows that a startup after a turnaround can injure people who are not part of the startup: 23 workers were hurt when an emergency relief discharge of ethylene ignited near nonessential contractors. 5
Pressure and leak tests before start-up are planned in hydrotest and leak test planning.
The CSB found welding by the nonessential contractors likely supplied the ignition source, that the company had an unwritten practice to exclude such workers but no formal exclusion zone, and that neither procedures nor operator training covered the conditions that should prompt exclusion. 5 See plant start-up after shutdown.
Checklist

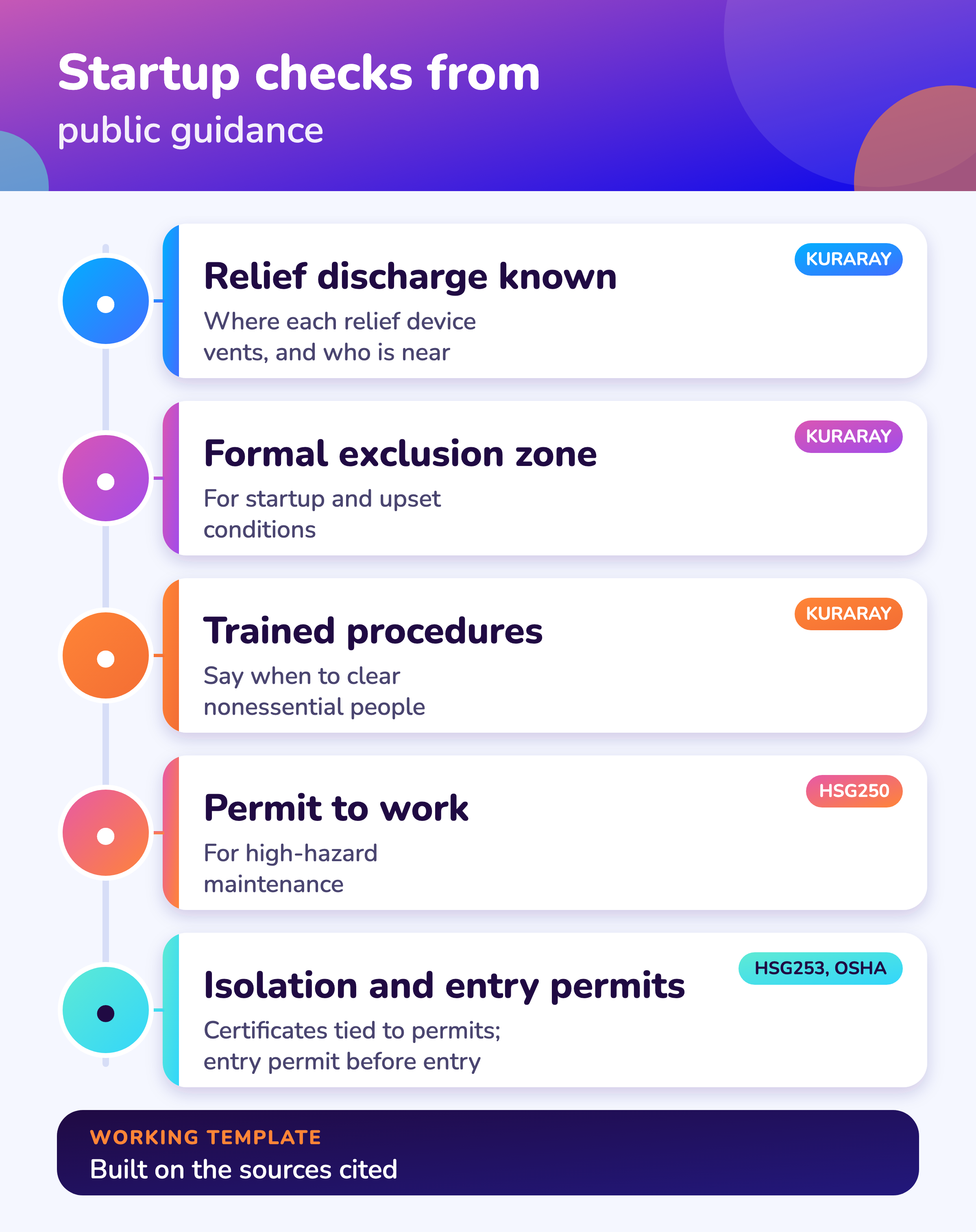

What belongs on a chemical plant shutdown checklist?
A chemical plant shutdown checklist should confirm relief discharge locations, an exclusion zone for startup, trained procedures, permits, isolation certificates, entry permits and contractor control.
A free Excel version is available: Chemical plant shutdown checklist (.xlsx). Equipment guides: heat exchanger turnaround planning and hydrotest and leak test planning.

| Check | Basis |
|---|---|
| Know where each relief device discharges | At Kuraray the emergency pressure-relief system discharged ethylene through horizontally aimed piping into an area where contractors were working |
| Formal exclusion zone while hazardous material is reintroduced | Kuraray had an unwritten practice but no formal zone |
| Procedures and training say when to clear nonessential people | The CSB found neither covered the conditions that should prompt exclusion |
| Permit to work for high-hazard maintenance | HSG250 sets out the system for the chemical industry |
| Isolation certificates cross-referenced to permits | HSG253 says certificates support the main permit |
| Confined space entry permits ready | OSHA requires an entry permit before entry is authorized |
| Contractor selection, information and review | HSG159 five steps; OSHA 1910.119(h) |
A working template based on the sources cited. The general list is the 40-step shutdown checklist.
FAQ
Frequently asked questions
How often do chemical plants shut down?
There is no published frequency. Review cycles in OSHA's standard, manufacturers' recommendations and your own inspection history set the dates.
How long does a chemical plant turnaround take?
There is no published duration. Duration follows scope, crews and the longest lead items.
How often must a process hazard analysis be updated?
At least every five years after the initial analysis, under OSHA's process safety standard. 1
What decides how often equipment is inspected?
The frequency must be consistent with manufacturers' recommendations and good engineering practice, and more frequent if prior operating experience requires. 1
What is HSG159?
HSE's guide to managing contractors, aimed at small and medium chemical companies, with five steps: plan, choose, work on site, keep a check and review. 4
What happened at Kuraray in 2018?
An ethylene release and fire injured 23 workers during reactor startup after a turnaround; the CSB found nonessential contractors' welding likely ignited it. 5
Do isolation certificates replace permits?
No. HSE says they support the permit and should be cross-referenced to it. 3
What rules apply outside the US and UK?
This page does not cover them. Check the law that applies where the plant is located; Seveso III was not read in its primary text.
Sources
Sources
- OSHA, 29 CFR 1910.119, Process safety management of highly hazardous chemicals
- UK Health and Safety Executive, Guidance on permit-to-work systems: a guide for the petroleum, chemical and allied industries (HSG250, 2005)
- UK Health and Safety Executive, The safe isolation of plant and equipment (HSG253, 2006)
- UK Health and Safety Executive, Managing contractors: a guide for employers (HSG159, 2nd edition, 2011)
- US Chemical Safety and Hazard Investigation Board, Ethylene Release and Fire at Kuraray America, Inc. EVAL Plant, Pasadena, Texas (No. 2018-03-I-TX, 16 December 2022)
- OSHA, 29 CFR 1910.146, Permit-required confined spaces
- American Petroleum Institute, API 510 Pressure Vessel Inspection Code, 10th edition summary (May 2014)
Keep permits and isolations tied to the work
Book a demo and bring your permit process. We will show how ePTW permits and isolations appear on each work order.
